Change orders statuses

PCOs, CORs, OCOs, SCOs, RFQs and cost items all have their unique budget and cost status flows. Most of these statuses are changing as change order process is progressing. For example, an owner executes an OCO when the payment is sent.

In this article, you'll learn about statuses for:

PCO Statuses

The following is a typical flow of statuses for PCOs:

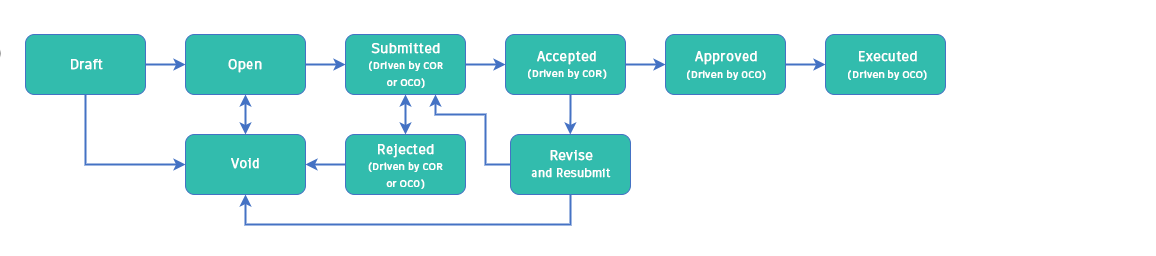

PCO Budget Status Workflow

Note: The In Review budget status only appears when a project administrator has configured a PCO change request approval workflow (used when a PCO is used as COR). See Approval Workflows.

Potential change orders have the following budget statuses:

Tip: Budget columns such as Pending Owner Changes reflect PCO budget statuses. To break out Accepted changes separately from other pending owner changes in the budget table, see Example: Reconcile pending owner changes with a custom column.

The following is a typical flow of statuses for cost PCOs:

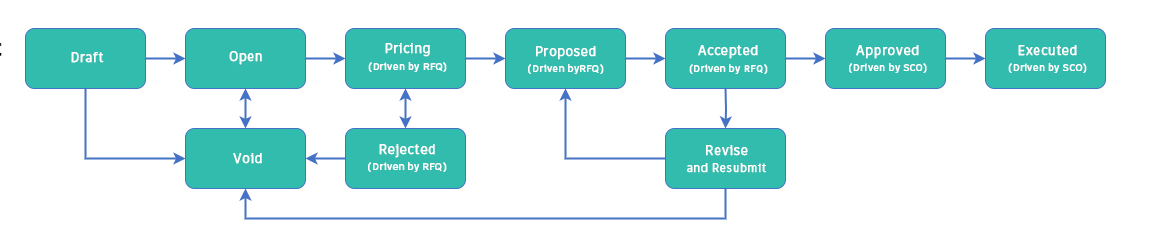

PCO Cost Status Workflow

Note: The In Review cost status only appears when a project administrator has configured a PCO supplier quotation approval workflow (used when a PCO is used as RFQ). See Approval Workflows.

Potential change orders have the following cost statuses:

To learn more about PCOs, see the Potential Change Orders article.

COR Statuses

Typical COR status workflow:

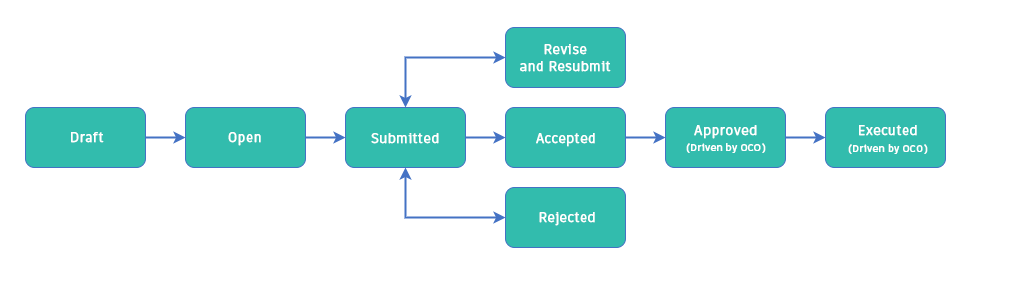

RCO Status Workflow

Requested change orders have the following statuses:

To learn more about CORs, see the CORs, OCOs and SCOs article.

OCO Statuses

Typical OCO status workflow:

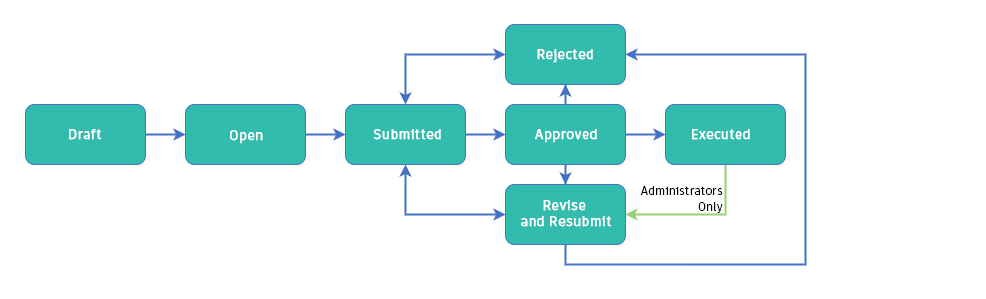

OCO Status Workflow

Owner change orders have the following statuses:

To learn more about OCOs, see the CORs, OCOs and SCOs article.

SCO Statuses

Typical SCO status workflow:

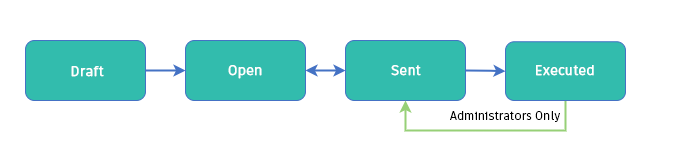

SCO Status Workflow

Subcontractor change orders have the following statuses:

To learn more about SCOs, see the CORs, OCOs and SCOs article.

Statuses for RFQs

Typical RFQ status workflow:

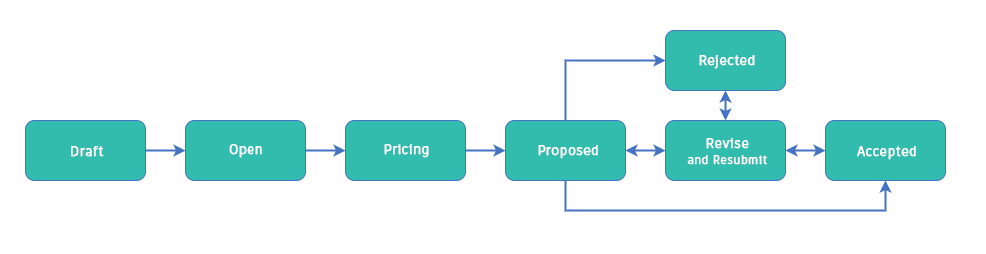

RFQ Status Workflow

Note: The In Review status only appears when a project administrator has configured an RFQ approval workflow. See Approval Workflows.

Request for quotations has the following statuses:

To learn more about RFQs, see the Requests for Quotation article.

Cost Item Statuses

Cost items status automatically updates with status changes from PCOs or CORs. Cost items have the following budget statuses:

Cost items status automatically updates with status changes from PCOs or CORs. Cost items have the following cost statuses:

To learn more about cost items, see the Cost Items article.
