Requests for Quotation

A Request for Quotation is a document sent to a supplier or subcontractor to obtain pricing using data from Cost Management. There are two ways to generate an RFQ document:

In this article:

RFQ Tab Overview

The Request for Quotation (RFQ) tab is within the Change Order tool in Cost Management. Tab names can be customised by project administrators within settings.

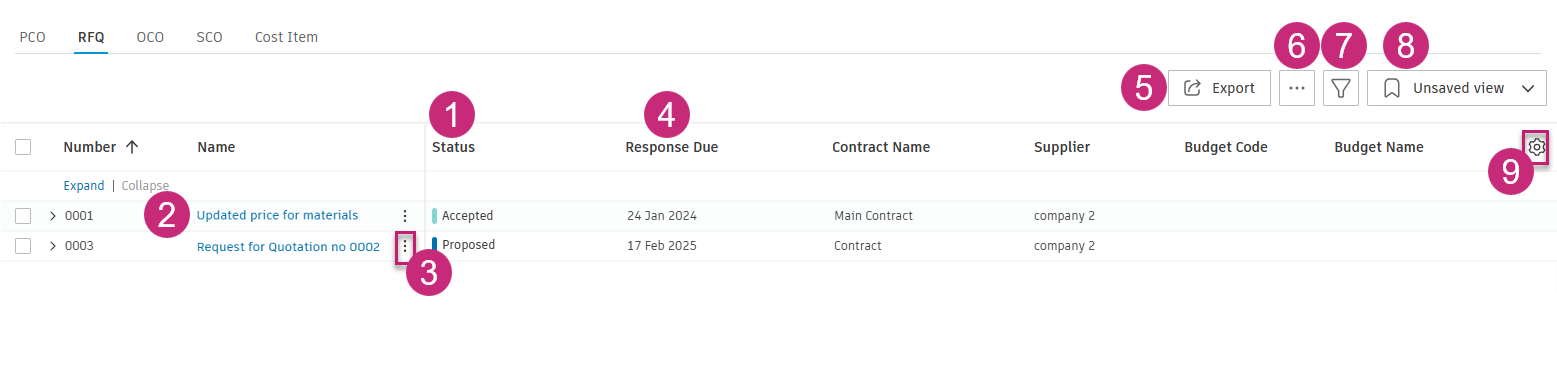

RFQ tab overview

  1. The item's status automatically updates to Draft after an RFQ is generated from a PCO.

  2. Select the item's name to open the flyout panel. Editing the RFQ can be done within the flyout panel. In the flyout panel, selectable workflow-based actions will appear to guide you through the change order management process.

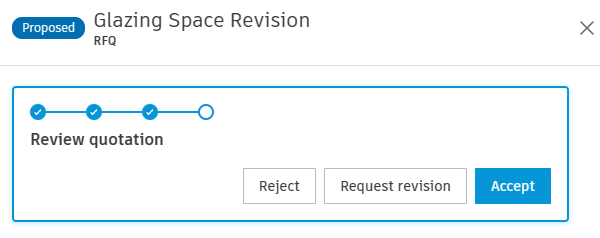

    RFQ workflow actions in the flyout panel

    For example:

    • When the RFQ status is Open, the Request Quotation button is visible. Note that a supplier needs to be listed in the Supplier Details section.
    • Once the RFQ is sent, the next options appear: Set as Proposed or Reject and so on.
    • When Accepted, select SCO to generate a Supplier Change Order.
  3. Click the More menu Vertical more menu icon to generate change orders, set the status of the RFQ or delete the item.

  4. The Response Due column will be populated when a date is added in the dates section of the flyout panel.

  5. Click Export to create an RFQ report.

  6. Click this icon to show or hide change orders' hierarchy. To learn more about using the hierarchy view to navigate between related change orders, see the Navigating Change Orders with Hierarchy View section.

  7. Click the Filter icon to filter and group the table.

  8. See the available predefined views of the table or save the current view of the table.

  9. Select the Settings gear icon icon to edit the position and visibility of columns within the table.

    Tip: By activating an Attachments column, you can instantly view the quantity of attachments for each RFQ, without the need to click each one individually.

Generate an RFQ from a PCO

Important: Before you can generate an RFQ document, a project administrator must create the RFQ document template in the Project Admin module. See the Document Templates in Cost Management article to learn more.

As a project administrator, you can generate an RFQ after the RFQ document template is created and a cost item associated with a budget is assigned to a PCO. To do so:

  1. Select the Change Order tool.

  2. Select the PCO tab.

  3. Tick the box for a PCO.

  4. Click the More Vertical more menu icon menu.

  5. Choose Cost Change and then Generate RFQ. Individual RFQs are created for each cost item within the PCO.

  6. Switch to the RFQ tab and check the newly created RFQ.

  7. Enter the necessary values into the Estimated and Proposed columns. You can copy cost item amounts from another column.

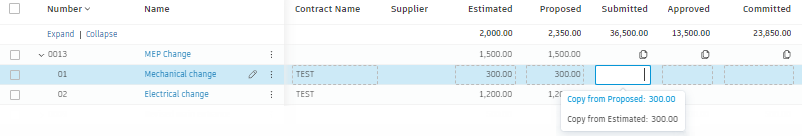

    Copy cost item amounts from another column in the RFQ table

  8. Open the newly created RFQ by clicking on its name. The flyout panel opens.

  9. Click Set as Open.

  10. Modify the following fields as required:

    • RFQ Name in the Details section
    • Due Date in the Dates section
    • Scope description in the Scope of Work section
  11. In the Documents section, create a document package and add additional attachments as required for the RFQ.

  12. Choose a supplier name in the Supplier Details section if one is not already selected.

  13. Click Request Quotation. The Send Email to Supplier window opens. The supplier contact from the PCO flyout is the default recipient. You can change this contact in the:

  14. Fill in all necessary fields, and then click Send.

Once the RFQ is sent, the next options appear: Set as Proposed or Rejected and so on. See the Change Order Statuses article to learn more about the RFQ status workflow.

A supplier will be notified of the quotation request by email when they have a collaborative permission for RFQs. The status is set as Pricing. See the Change Order Statuses article to learn more about the RFQ workflow statuses.

Note: You can also generate an RFQ as a PCO in a collaborative workflow. See the Collaborative Potential Change Order article. You can also generate an RFQ from a cost item.

When Accepted, project administrators can request extra revision or generate SCO to finish the change order workflow.

Batch Request Quotations

In addition to generating an individual RFQ, you can batch-request quotations from a PCO. A batch-request quotation is useful when a change occurs, and it is unclear who might be affected by this change. To reduce the risk of missing anyone, send a batch request to all suppliers to let them indicate whether they are affected or not and keep a record of their response.

To create a batch request:

  1. Click the Change Order tool.

  2. Click on the PCO tab.

  3. Click the More Vertical more menu icon menu of a PCO and choose Batch Request Quotations.

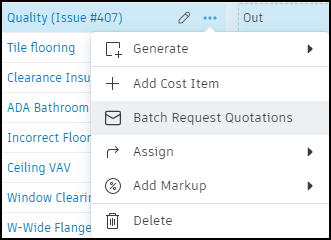

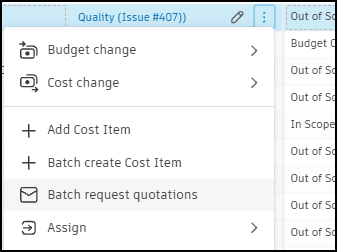

    Batch request quotations option in the PCO More menu

  4. You can add a filter for contract type in the newly opened window.

  5. Select one or more suppliers.

  6. Optional: In CC, select project members who should receive a copy of the batch request email.

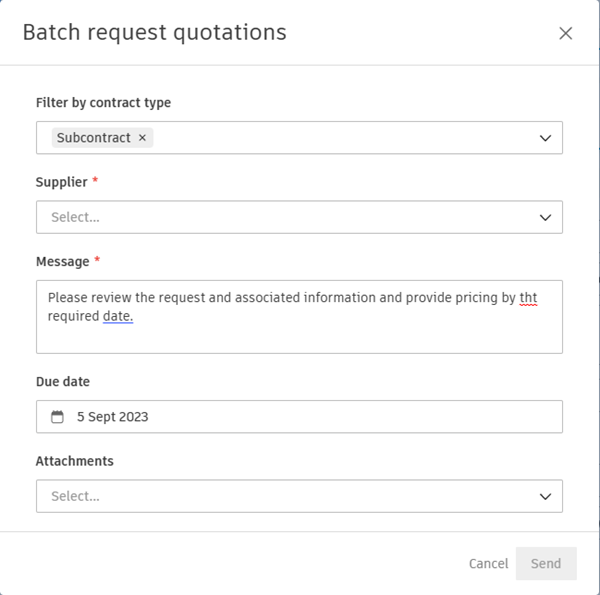

    Batch request quotations window with contract type filter, supplier, CC, message, due date and attachment fields

  7. Write a message to be included with the request.

  8. Select a Due date.

  9. If necessary, choose Attachments to include.

  10. Click Send.

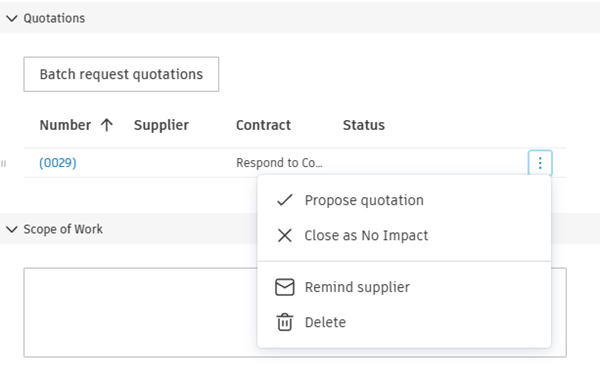

Placeholder cost items are generated for each supplier and are shown in parentheses. Suppliers can respond by saying no impact or can propose a quotation.

Placeholder cost items shown in parentheses in the PCO table

The placeholder cost items will be converted to regular cost items when a quotation is proposed.

Respond to an RFQ (Supplier Workflow)

When a supplier receives an RFQ notification email and has collaborative permission for RFQs, they can respond in two ways:

Option 1: Respond via email

You can reply directly to the RFQ notification email with your quotation and comments. Your email attachments and message will be automatically captured in Cost Management. To learn more, see the Respond to Cost Management Emails article.

Option 2: Respond in Cost Management

  1. Open the email and select Open in Cost Management. When Cost Management opens, only the information pertaining to a supplier will be visible.

  2. Click the Request for Quotation name to open the details flyout panel.

  3. Scroll to review information and access any associated documents.

  4. When ready, select Respond in the workflow bar.

  5. Under the Scope of Work section, click to add the appropriate unit cost. The amount will auto-populate.

  6. Add files in the Documents section. You can:

    • Upload from your computer

    • Attach from Forma Data Management

    • Add from linked references

      Note: When an attachment is uploaded to an RFQ, it's added automatically to the cost item and the RFQ.
  7. Include a comment within the Comment section and select Submit.

Once submitted, the system will notify a general contractor by email. They can review all RFQ quotations in the PCO view by selecting each cost item and looking at the attachment. Then they can either accept it or request a revision.

Note: If a project administrator has configured an RFQ approval workflow, the supplier's submission triggers an internal review and the RFQ moves through In Review to Accepted, skipping Proposed. See RFQ Approval Workflows.

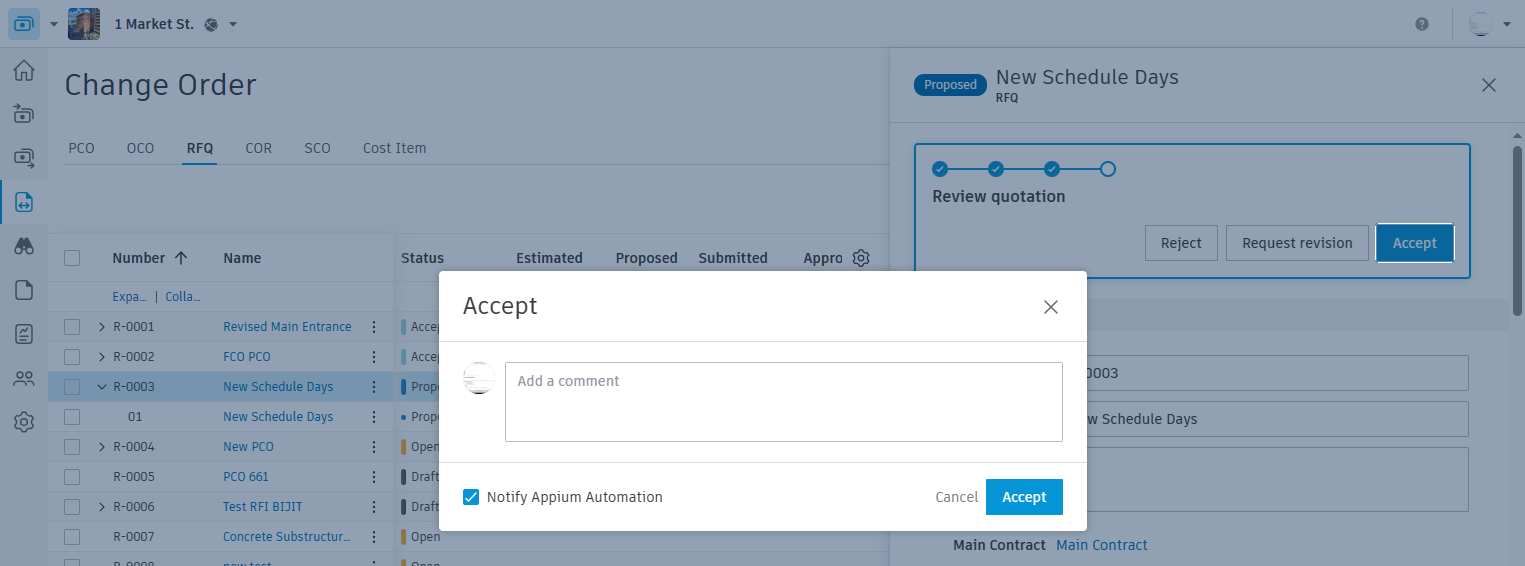

Supplier response example

Tip: When a subcontractor selects No Cost Impact, the RFQ is closed without any cost items. However, the general contractor can reopen it by clicking Reopen and propose quotation in the More menu Vertical more menu icon. This action will create a cost item with a value of 0 and set the RFQ status to Proposed.

When a revision is required, the process will continue as outlined once it is submitted back to a supplier. If necessary, a formal quotation can be attached by a supplier when responding. Once accepted by a general contractor, the system will notify a supplier by email.

When a change order is in the Proposed, Accepted or Rejected status, a supplier with collaboration permission can read cost information or download documents in the view-only details panel. Click View Cost Detail in the More menu Vertical more menu icon.

View Cost Detail option in the More menu for accessing cost information and documents

RFQ Approval Workflows

A project administrator can configure an RFQ approval workflow in settings so supplier-submitted quotations are reviewed internally before the RFQ is finalised. This is useful when the cost or estimating team needs to validate pricing before it's presented to the owner or used to generate an SCO.

The workflow runs automatically when:

When triggered, the parent RFQ moves to In Review. Cost items inside the RFQ stay in Pricing or Revise and Resubmit until the review completes.

When the final reviewer approves, the RFQ moves to Accepted. If the workflow has Automatically generate SCO turned on, the system also creates a draft SCO and includes the link in the email to the creator. If a reviewer responds with Revise, the RFQ moves to Revise and Resubmit. With Reject, it moves to Rejected.

Note: If the project process has Use Potential Change Order to Request Quotations turned on, the RFQ table is replaced by the PCO-as-RFQ flow. In that case, configure the workflow under PCO supplier quotation approval workflows.
Note: While the linked SCO is in approval review, the RFQ workflow can't trigger; the same applies in reverse. See Approval Workflows.

For configuration steps, permissions, reviewer roles and in-review item editing rules, see Approval Workflows.

Change Response Due Date for RFQ

By default, the Response Due date for RFQs is set to seven days after creation. Project administrators can adjust this default setting as follows:

  1. Select the Settings tool from the left navigation.
  2. Switch to the Change Order tab.
  3. In the Dates drop-down list, click Edit next to the Response Due option.
  4. Enter the Default Value and decide whether you want to display the date on the Home Page.
  5. Click Save.

Detach a Cost Item from an RFQ

To detach a cost item from an RFQ, expand the row and select the More menu Vertical more menu icon or tick the box. The detach button will appear. It will still be part of the PCO.

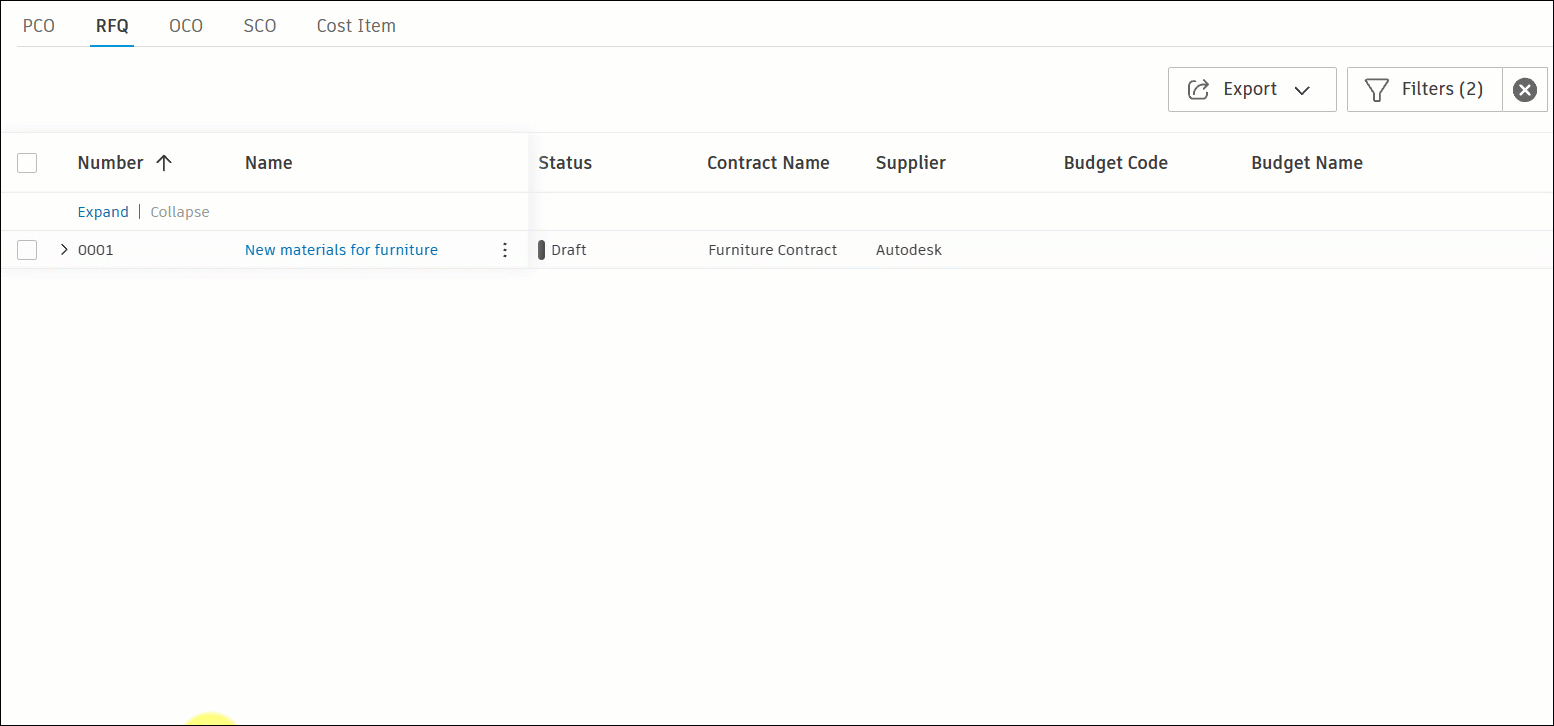

Detach RFQ process

Delete an RFQ

To delete an RFQ, select the More menu Vertical more menu icon next to the item's name. To delete more than one RFQ, select the box next to the items and click Delete.

Export an RFQ Report

You can export an RFQ report that will contain all details or a minimum number of them. To do so:

  1. Select the Change Order tool from the left navigation.

  2. Switch to the RFQ tab.

  3. Click Export Export button.

  4. Choose one of the following:

    • PDF Report – to export a report in a non-editable PDF format.
    • Excel Report – to export a report in an editable Excel format.
  5. Add the Report Title.

  6. Choose the Report Template:

    • Current View – you can export a report from the current view, for example with applied filters.
    • System Default Report – you can export a report with all default columns.
  7. Choose whether you want to include the Cost Item information in the report. By unselecting this option, you can export a report only with the minimum details.

  8. Add an optional message.

  9. Click Run report.

You'll receive the report by email. You can also find and download it from the Reports tool. To learn more about cost report types, see the Cost Reports article.

Reports for Collaborative Access Members

Members with collaborative access are able to export reports from change order tables (PCO/RFQ/COR/OCO/SCO).

Note: The access rights to each table are determined by permission settings.

The change order report displays the corresponding cost items along with their amounts. RFQ reports, for example, include proposed amounts. However, the budget code and name are not visible in these reports.
