Potential Change Orders

Potential Change Orders (PCOs) are the starting point of any budget or cost change. You can generate other change orders from a PCO. Link cost items to provide a connection back to the affected budget, contract and supplier. However, cost items can also be created directly in the Cost Item tab and assigned to a PCO later.

In this article:

Potential Change Order Tab Overview

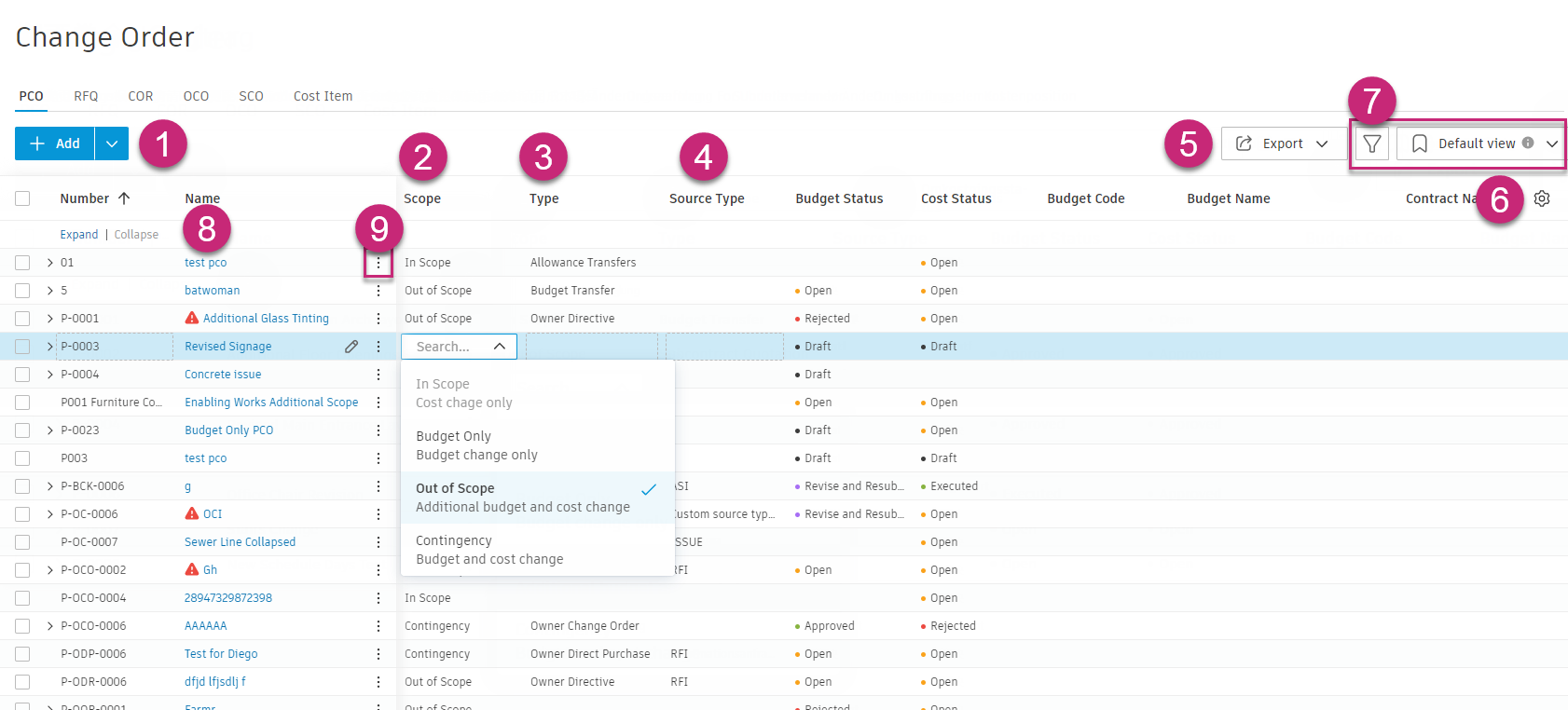

PCO tab overview

  1. Select Add to create a PCO.

  2. Select In Scope, Budget Only, Out of Scope or Contingency to change the order's scope. When a change is budget-side only, simply do not add any values to the Estimated, Proposed or Committed columns.

  3. Type is an optional field if you’d like to number, track or group change orders by their type.

  4. Source Type and Source Ref are also optional, and you can use them to track or group based on the origin of the change.

  5. Export allows you to export a PDF or CSV PCO report.

  6. Column settings allow you to select the columns you wish to include in your view.

  7. The view selector allows you to store and recall your preferred grouping or column visibility. See the Filter and Group article to learn more.

  8. Select the PCO name to open the flyout panel. The Edit icon allows you to edit the name. Scroll down to edit the Cost Summary section, where you can edit Qty, Unit, Unit Cost and Amount for each status.

  9. Select the More menu More menu icon to add cost items, duplicate, change status and more.

    Tip: You can create up to 100 cost items at once by choosing Batch create Cost Item, or import cost items and sub-items from Excel by choosing Import Cost Item.

Create a Potential Change Order

A PCO is the starting point for any change order. You can create it manually in the Change Order tool or create a PCO from an RFI, Issue or Submittal Item.

To create a PCO:

  1. Select the Change Order tool from the left navigation.

  2. Select the PCO tab.

  3. Click Add.

  4. Enter a name for the PCO.

  5. Set the Scope to In Scope, Budget Only, Out or Contingency. The scope determines where the PCO appears in the budget and contract overview. You can also change the scope on the cost item level. Choose the scope from the available options:

    • In Scope: Represents a cost-side change only, without affecting the budget.
    • Budget Only: Indicates a budget-side change only, with no cost-side impact.
    • Out of Scope: Refers to a budget-side change for items not included in the original scope. The owner will allocate extra budget through a PCO to cover the cost.
    • Contingency: Denotes a change that is out of scope funded by transferring amounts from an existing contingency budget.
    Tip: To learn more about scopes and how change orders populate in the budget and contract tables, see the Budget and Contract Tables article.
  6. Choose a PCO Source Type. Available source types are:

    • ASI: Architect's Supplemental Instruction
    • CCD: Construction Change Directive
    • INT: Internal
    • ISSUE: Issue
    • RFI: Request for Information
    • RFP: Request for Proposal
    • T&M: Time and Materials
    Tip: You can deactivate the default types or add your own. See the PCO Source Types section in the Change Order Settings to learn more.
  7. Select or enter a Source Ref #. If the PCO is generated from an issue, you can select the issue. If the PCO is entered manually, you can enter any reference number.

To add a location to a PCO, use the Location field within the table. By doing this, you can filter and group to see a location-based view of changes. Project administrators configure locations within Build’s settings.

Now you can add more details to a PCO or generate a change order. Leaving a PCO as a draft will mean that any costs are not shown or used in calculations in the budget or contract overview. Setting the status to Open triggers those calculations, and the impact will be shown in the overview.

Create a Potential Change Order (PCO) from Project Management Workflows

It’s common for an Issue or RFI to incur a potential cost change. In such cases, Forma Build members can generate a Potential Change Order directly from the item. This streamlines the process and creates a connection between the workflows, reducing the risk of data loss and capturing the origin of the change order.

To work with this workflow, members need Full Control permission level for Cost Item and PCO in Cost Management.

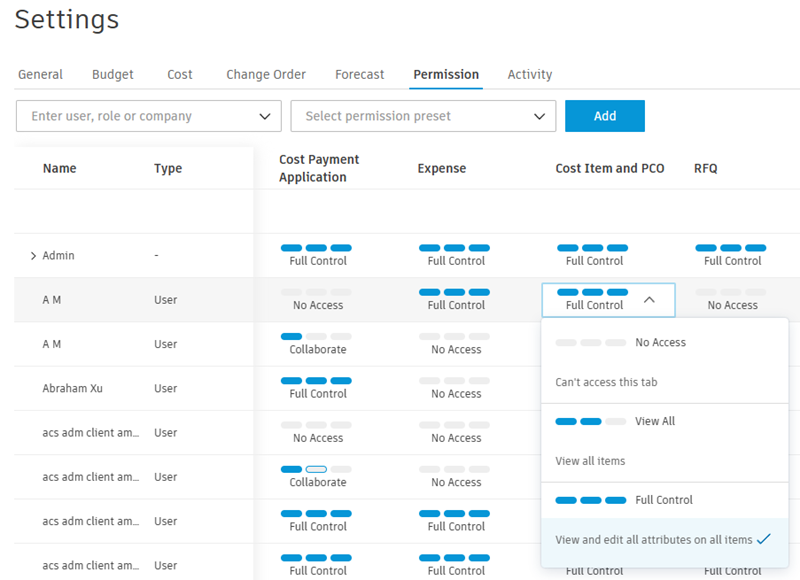

Full control permission

Create a PCO from an RFI, Issue or Submittal Item

From either a new or existing RFI, Issue or Submittal item record:

  1. Scroll to References and select Add reference.

  2. Choose PCO.

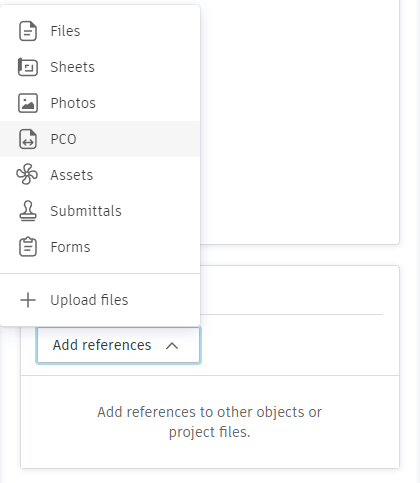

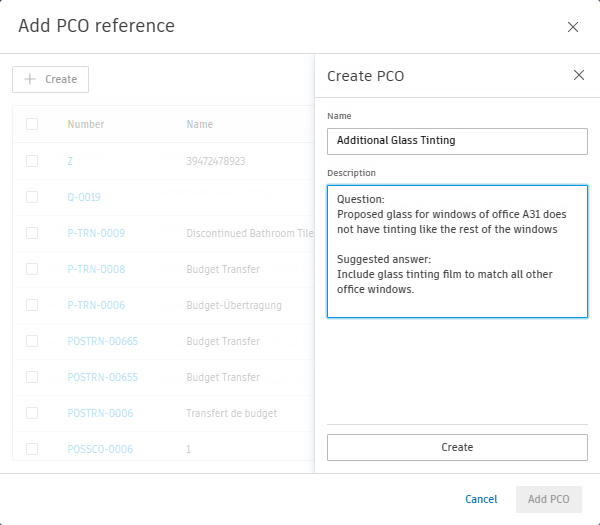

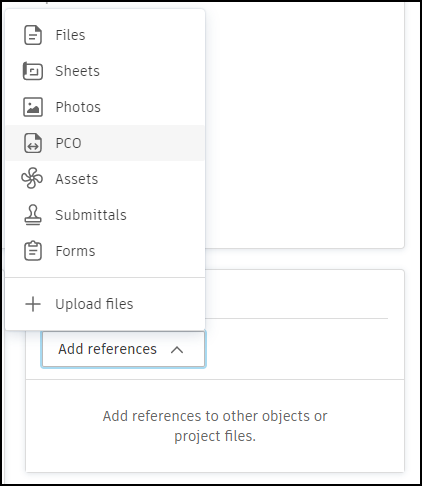

    Add PCO from RFI

  3. In Add PCO Reference, select Create.

  4. Fill in the PCO name and description, then select Create.

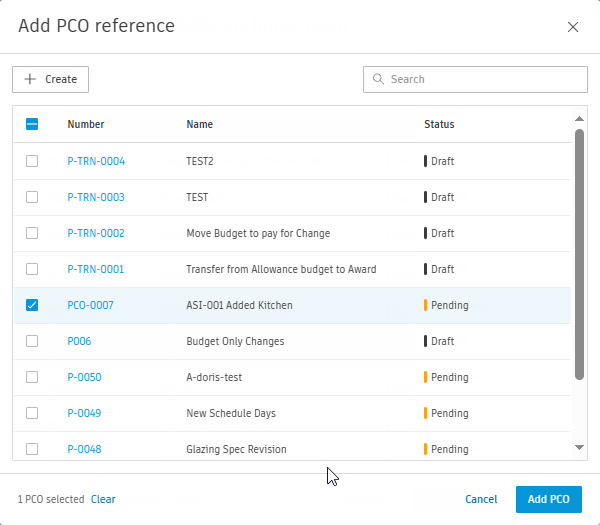

    Add PCO reference

This information will populate the new PCO record within Cost Management, where it can be altered later.

To link existing PCO(s) to project management items, follow the steps in the previous section, but instead of creating a PCO, choose the existing PCO(s) from the list and click Add PCO.

Add PCO

Within the RFI, Issue or Submittal item list view in the Linked References column, select the PCO number to open the PCO in Cost Management. If the member does not have the correct permission level, this option will not be accessible.

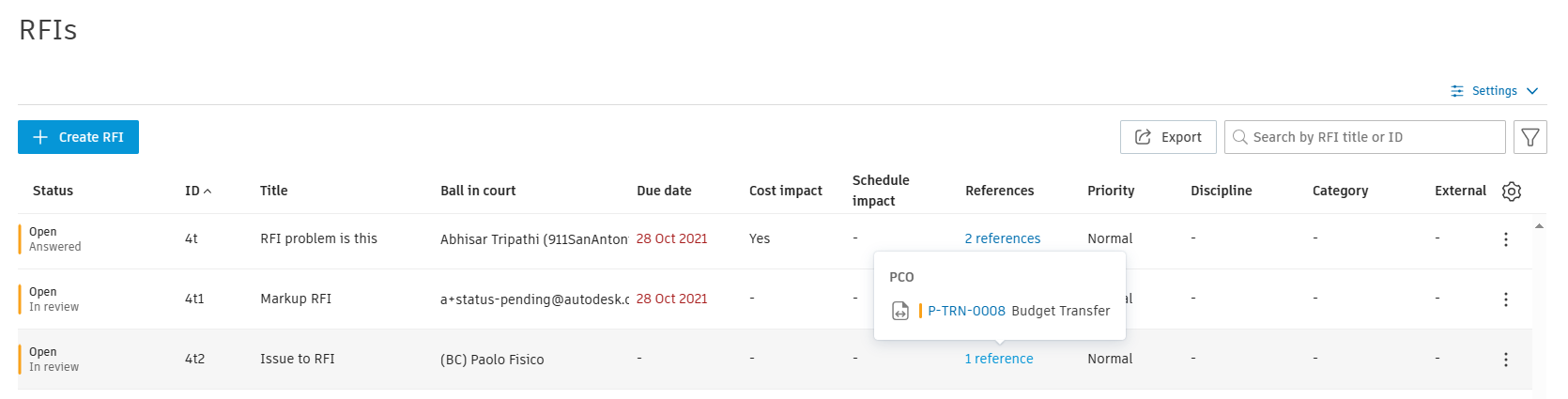

RFI list references

An RFI is also shown in the Linked References section in the change order's details panel when:

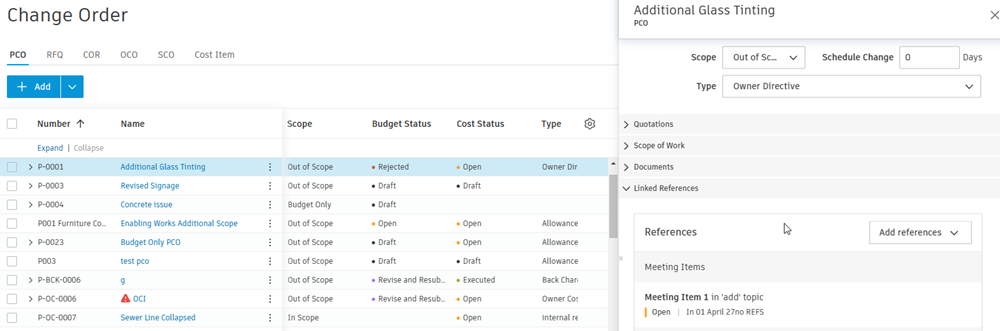

Linked references

Learn more about the RFI workflow.

Create a PCO Through the Change Order Transfer (Collaborative PCO)

Collaborative PCO users with Collaborate permission can generate change order transfers, which are net-zero PCOs that move the budget from one item to another without changing the total budget.

To create a change order transfer:

  1. Go to the Change Order tool in Cost Management and select the PCO tab.

  2. Click Change order transfer.

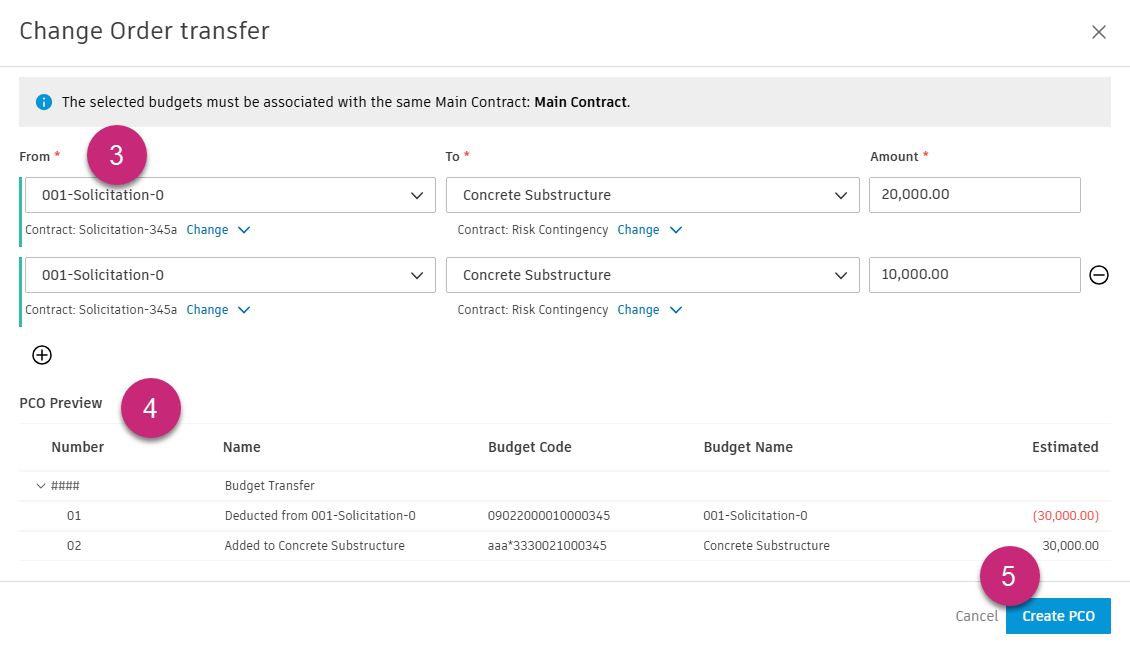

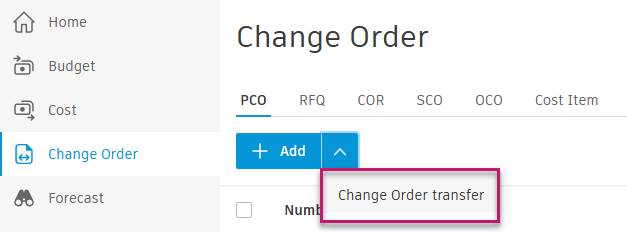

    Change order transfer

  3. In Add change order transfer from Contract:

    • If your company has only one associated supplier contract, the contract field will auto-populate.
    • Use the Schedule of Values picker to select the SOV items for the transfer (only budget-associated SOV items are listed).
    • Select From and To budgets to create the transfer.
  4. Review the PCO preview showing the combination of positive and negative cost items:

    • If budgets in From and To are linked to the same contract, positive and negative cost items are combined in the same PCO.
    • If not, positive and negative cost items are placed in separate PCOs.
  5. Click Add PCO.

    Change order transfer as collaborative user

  6. Submit the change order transfer PCO through the normal PCO workflow. See Create a PCO as a Collaborative Access User for further instructions.

Create a PCO from Forecast Adjustment

You can create a PCO from forecast adjustment to request extra budget. This can be done when project administrator set revenue forecast.

To do so:

  1. Open the Budget tool in Cost Management.
  2. Click the blue triangle in the Budget Forecast Adjustments column in the Budget Forecast section of the table. Those are visible if revenue forecast is on. The bottom flyout opens.
  3. Click the More More menu menu next to the forecast adjustment. Tip: You can also batch create PCOs from forecast adjustments. To do so, tick all the boxes next to forecast adjustments in the bottom flyout and click Generate PCO.
  4. Choose Generate PCO.

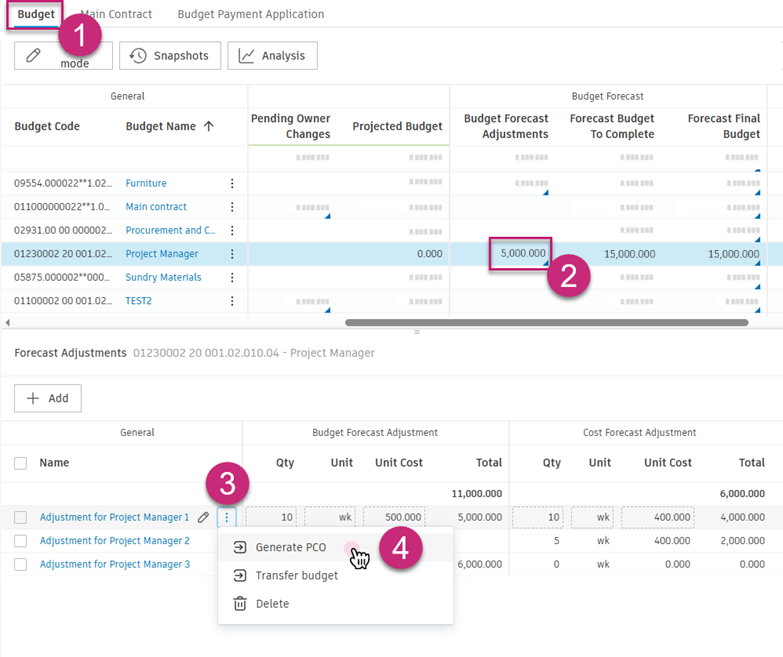

Create PCO from forecast adjustments

Tip: Alternatively, you can follow the procedure from the details panel of the budget. To open details panel, click the budget name and scroll down to Forecast Adjustments section.

The Generate PCO window opens. You can generate from budget forecast adjustment, cost forecast adjustment or both.

Generate PCO from forecast adjustments

After the PCO is generated, you'll see changes in the Pending Owner Changes. If you generated from budget forecast adjustment, Budget Forecast Adjustment Qty is set to 0. As a result, Amount is also set to 0. Unit Cost is not changed. There are three activity logs after this procedure.

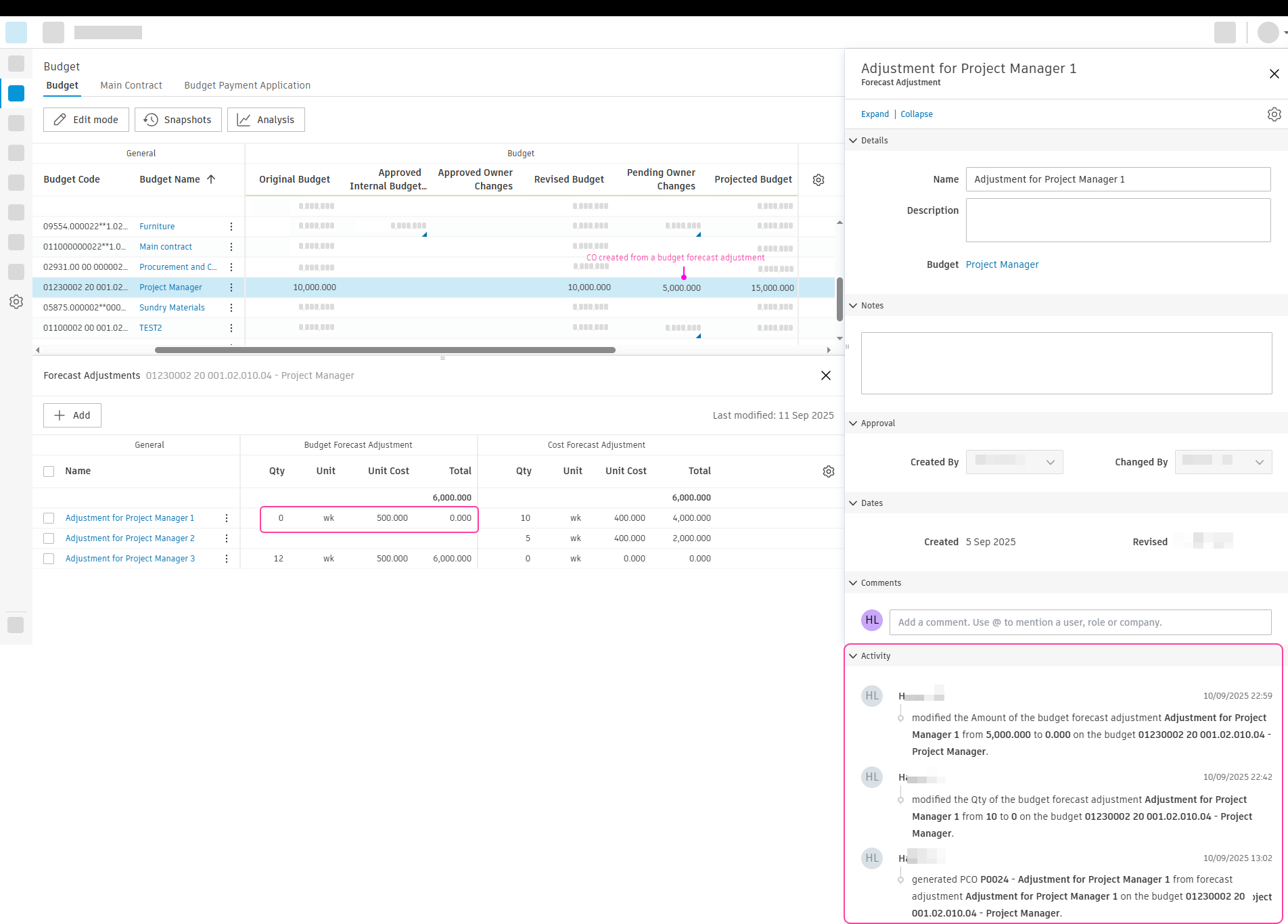

PCO from forecast adjustments – outcome

It's the similar rule for other options. If you generated PCO from cost forecast adjustment, you'll see changes in Cost Forecast Adjustment section and so on. If from both, you'll see changes in both places and there will be five activity logs.

Create a PCO as a Collaborative Access User

If you are a supplier with collaborative permissions and have been enabled by an administrator to create PCOs, you can submit a PCO.

Note: Make sure that the process is set correctly and that you have the proper permissions. Learn about the Setting Project Process for Downstream PCO Collaboration.
Tip: Learn more about Collaborate in Cost Management.

To create a PCO as a Collaborative Access User, follow these steps:

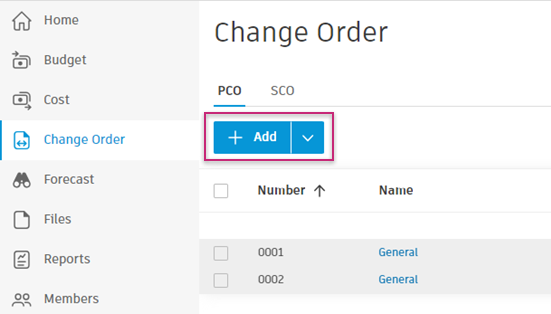

  1. Go to the Change Order tool in the menu. Click Add. Add Button

  2. Select the appropriate contract and choose your budget. Confirm with the Add button.

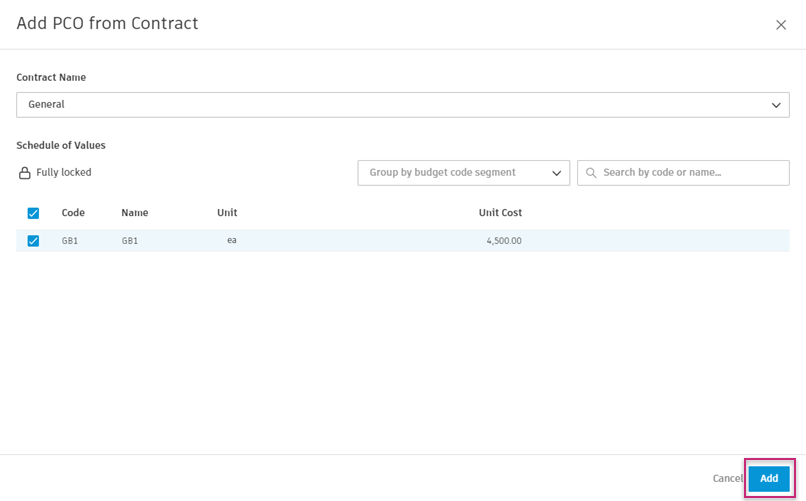

    Collaborative access contract selection

  3. Fill in the necessary fields and click Submit.

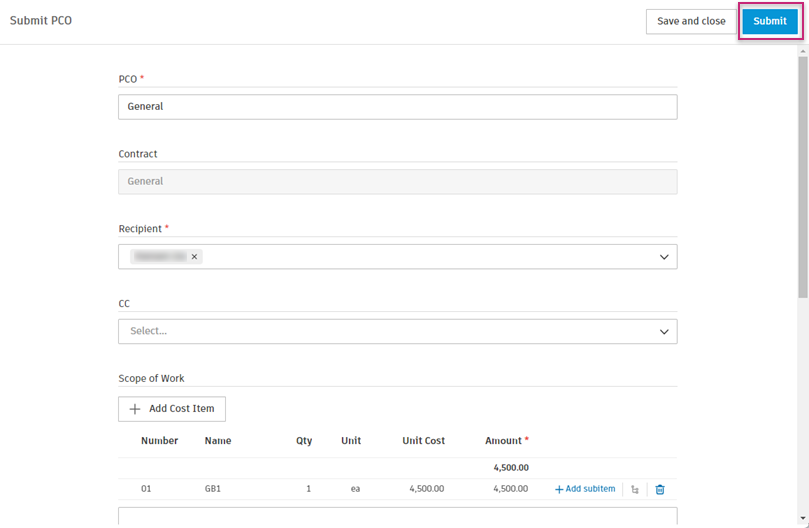

    Collaborative access submit button

    Your PCO is now proposed.

    Collaborative access proposed status

    Note: If you click Save and Close instead of Submit, the PCO will be saved as a draft (with the status Pricing). You can edit the fields later by clicking the More menu More menu icon and choosing Submit.

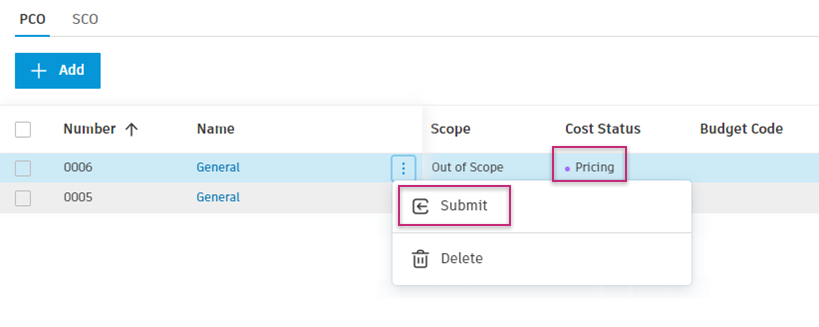

    Collaborative access pricing status

Submit PCO as COR Without Cost Items

When working with PCOs in an early estimation phase, you can submit a PCO for review without creating detailed cost items. This streamlines the workflow when you need to get budget approval quickly.

To submit a PCO without cost items:

  1. Create a PCO and enter values in the Estimated, Proposed or Submitted columns at the PCO level.

  2. Click the More menu More menu icon next to the PCO.

  3. Choose Budget Change, then Submit.

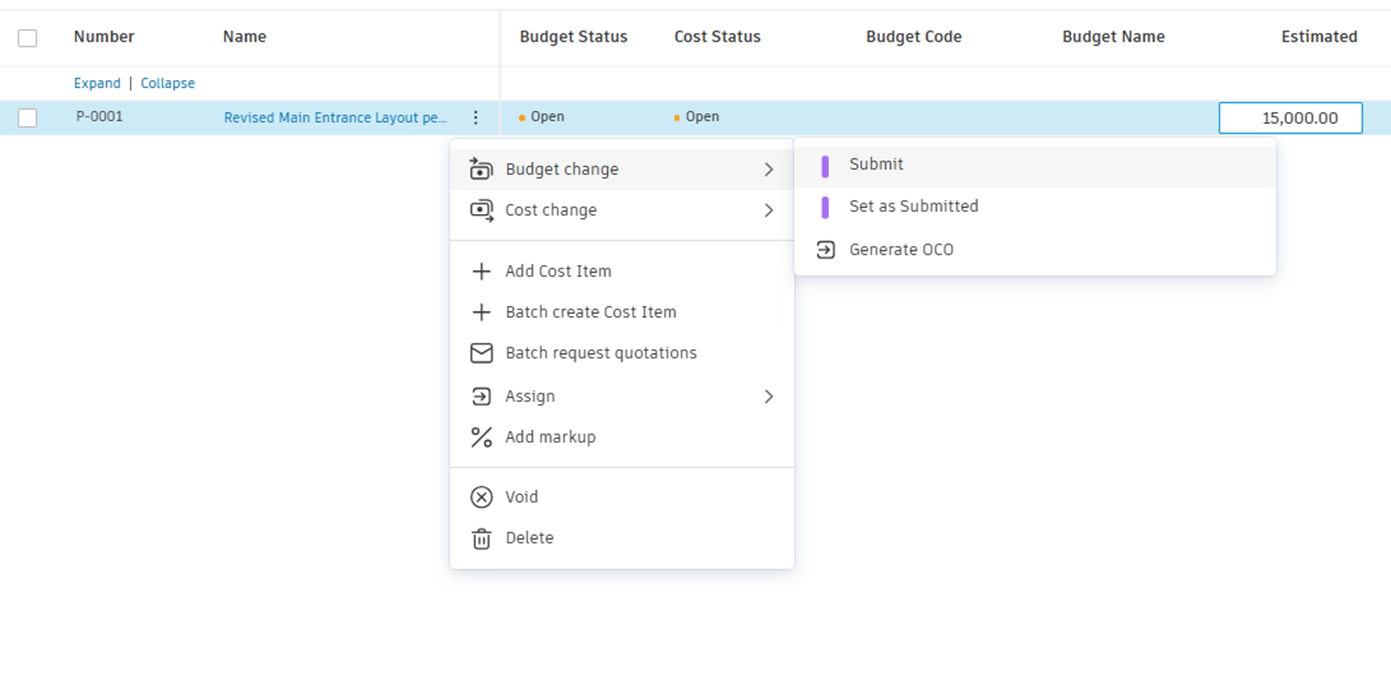

    Submit PCO without cost items

  4. If there is no Submitted value, the Submit PCO modal will only show the PCO level. Enter the Submitted value and click Submit.

    Submit PCO modal

  5. If there is a Submitted value, the PCO as COR can also be submitted with the Send for signature action. Once the document is signed and returned, PCO as COR will be automatically set as accepted.

Tip: Estimated, Proposed, Submitted columns are editable on PCO level when no cost items are attached. This allows for flexibility in the early stages of change order processing.

Respond to a PCO Without Cost Items

When responding to or reviewing a PCO that has no cost items, the interface displays information at the change order level only, simplifying the review process.

If there is no cost item, the CO level is shown in the Scope of Work (SOW) section. This applies to:

The change order level values are displayed but not editable during the response or review process. However, there is an exception: on the PCO as COR approval workflow review page, if editing is enabled and the PCO has no cost items, the PCO level value can be edited.

When viewing a PCO without cost items, the total on the summary line is removed since there are no subitems to aggregate.

Edit Existing PCOs

After the PCO is created, you can add more or modify details. To do so:

  1. Click on the PCO name to open the details panel.

  2. Add information to the applicable fields in the Owner Details or Main Contractor Details, Recipients, Scope of Work and other sections, including:

    • Name
    • Description
    • Cost Status (learn more about change order statuses)
    • Schedule Change (impact of the PCO, as measured in the number of days the project schedule is changed)
  3. Modify any previously defined fields if necessary.

Tip: To detach a cost item from a PCO, expand the row and select the item. A detach button will appear.

Edit PCO Values Directly

When there are no cost items attached to a PCO, you can edit the PCO's values directly in the table. This is useful for early estimation workflows when you need to create high-level estimates before breaking them down into detailed cost items.

Tip: This approach allows you to quickly capture initial cost estimates and submit them for review without creating detailed cost item breakdowns. You can add cost items later when more detailed information becomes available.

Duplicate a PCO

Duplicate an existing PCO to quickly create a PCO with similar content. This is useful when you have standard indirect budget codes required on all PCOs (like internal labour), or when you need to create multiple similar change orders.

Permissions required: Full Control permission for both PCO and Cost Item. See Cost Management Permissions to learn more.

To duplicate a PCO:

  1. Click the More menu More menu icon next to the PCO that you want to duplicate.

  2. Select Duplicate.

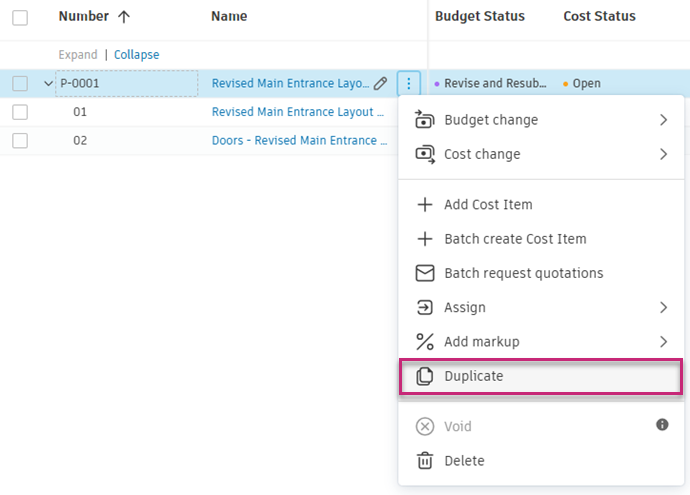

    Duplicate option

  3. A toast message appears to show the duplication is in progress.

  4. Once complete, a success message appears with a link to the new PCO.

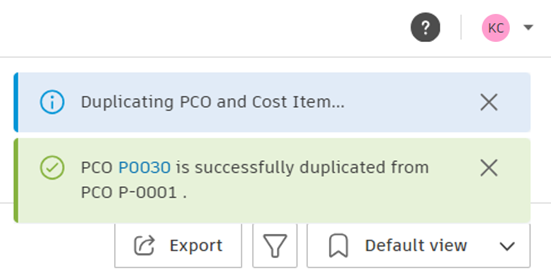

    Duplication complete

The duplicated PCO includes:

The duplicated PCO does NOT include:

Note: The duplicate option is disabled if the PCO has more than 200 cost items.

Generate Change Orders from a PCO

You can generate CORs, OCOs, SCOs and RFQs from a PCO. To do so, make sure that:

Note: For certain actions like generating change orders or applying markup, cost items are required. If you attempt these actions without cost items but with values entered at the PCO level, the system will guide you to add cost items first.

Then:

  1. Click the More menu More menu icon next to the PCO.

  2. If the scope of the PCO is:

    • In Scope – click Cost Change and choose Generate RFQ or Generate SCO.
    • Budget Only – click Budget Change to generate COR or OCO.
    • Out of Scope or Contingency – click Budget Change to generate COR or OCO and Cost Change to generate RFQ or SCO.
    Tip: To learn more about scopes and how change orders populate in the budget and contract tables, see the Budget and Contract Tables article.

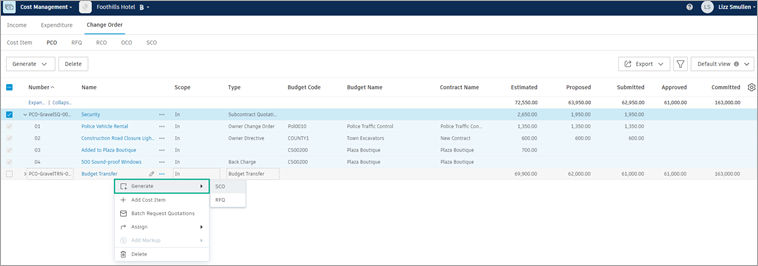

Cost PCO

The new change order is generated and you’ll be moved to the suitable tab to continue the workflow.

Note: If a generated RFQ (or a PCO used as an RFQ) is currently in an approval review, Generate SCO is hidden in the More menu until the review is completed. Similarly, if the linked SCO is in an approval review, the RFQ or PCO used as RFQ can't trigger its approval workflow. See Approval Workflows.

How Data Flows When Generating Change Orders from PCO

When generating change orders from a PCO, data flows through specific fields at two levels:

  1. Change Order Level: Used for general descriptions and the overall scope of work, which applies to the entire change order and all associated trades.
  2. Cost Items Level: Used for detailed descriptions and scope of work specific to individual budget codes or trades.

Example scenarios:

  1. Single PCO to OCO. If you generate one OCO from a single PCO:

    • The PCO description is copied to the OCO.
    • The scope is aggregated from the PCO and its cost items.

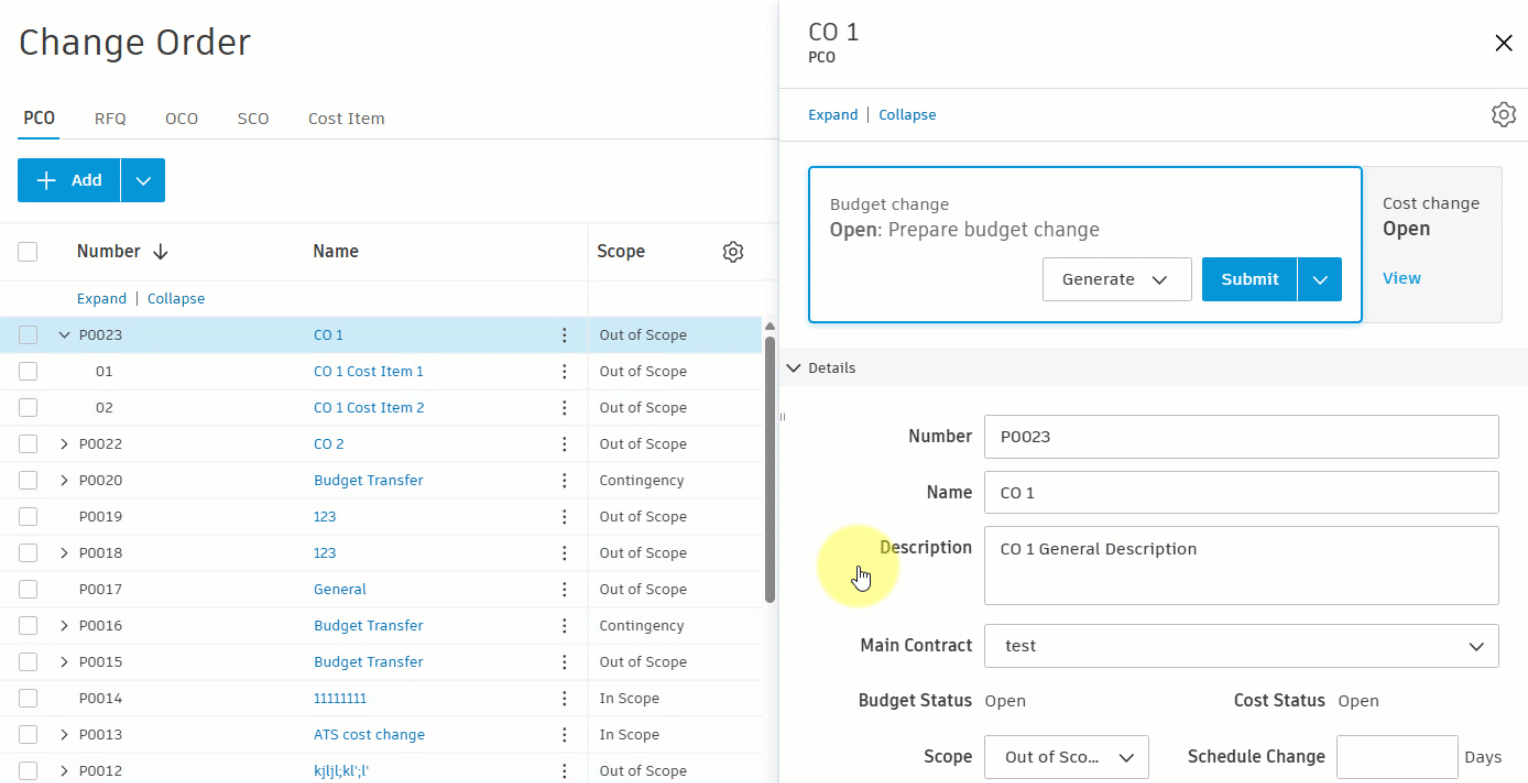

    Single PCO to OCO

  2. Multiple PCOs to OCO. If you generate one OCO from multiple PCOs:

    • Descriptions from all PCOs are aggregated and copied to the OCO.
    • Scopes from all PCOs and their cost items are aggregated and copied to the OCO.

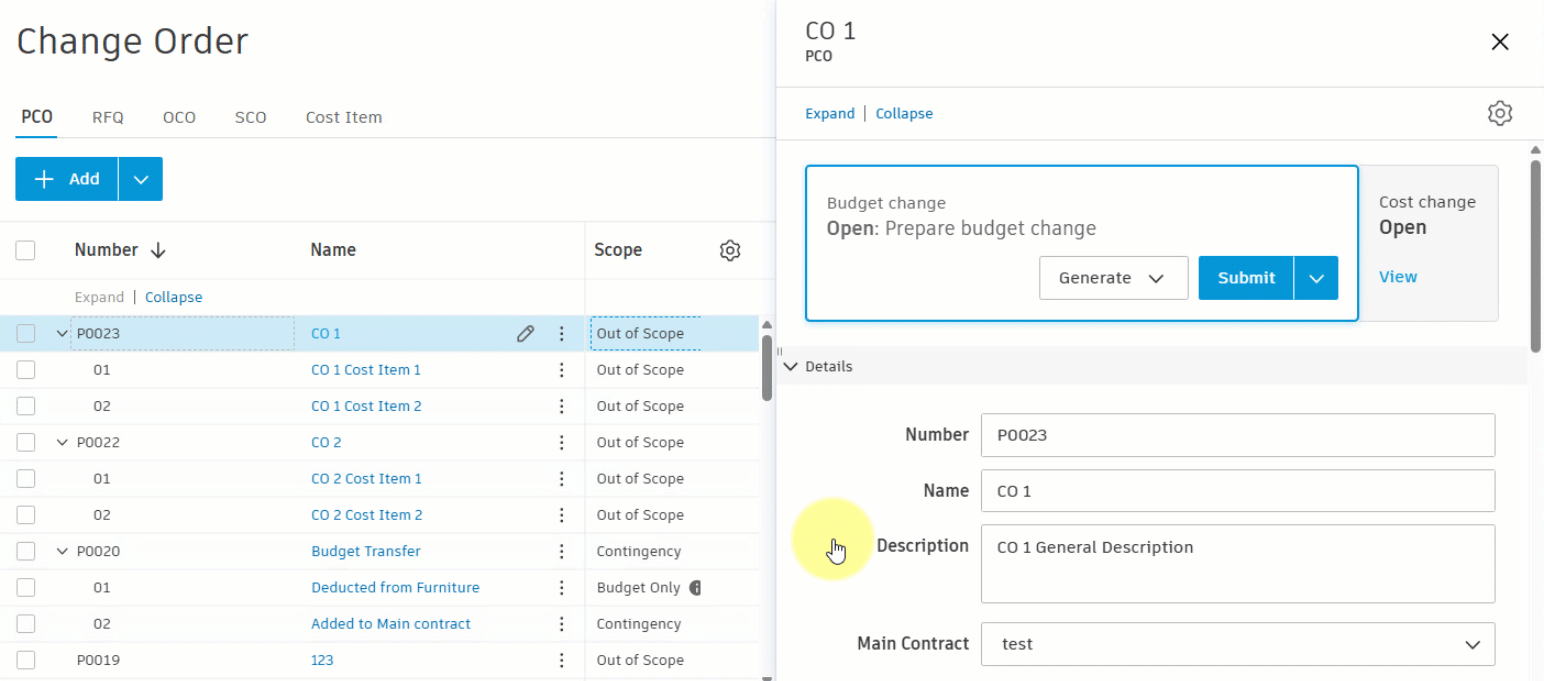

    Multiple PCOs to OCO

This workflow reduces manual data entry and helps carry relevant details forward accurately to the appropriate levels. By following this process, you can maintain consistency and streamline the generation of change orders from PCOs.

Change Scope on Cost Item Level in Change Orders

You can edit the scope field for individual change order subitems. This may be helpful in cases where one or more cost items are a budget-only transaction for a particular change order, such as transferring from a non-contingency, allowance or fee budget item. Scope options include:

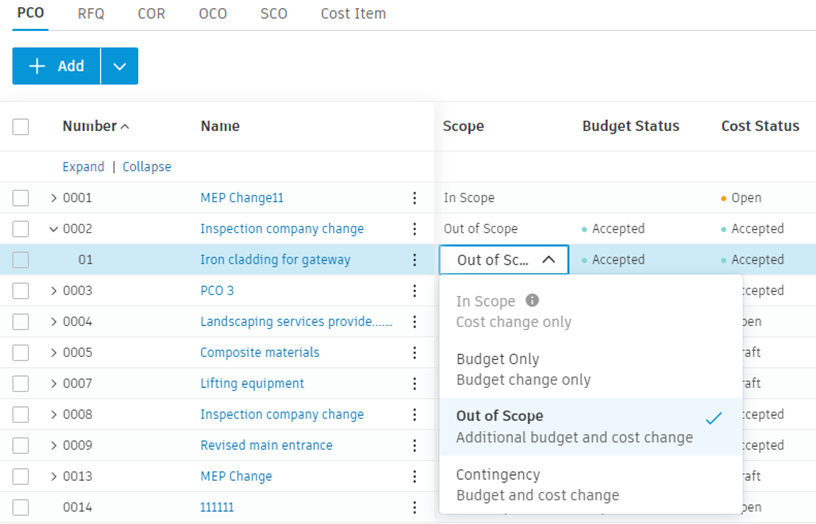

Cost item scope on change orders

Tip: To learn more about scopes and how change orders populate in the budget and contract tables, see the Budget and Contract Tables article.

Specific cost items can be excluded from the budget overview, even if the overall change order retains its original scope.

PCO Document Storage in Forma Data Management

When you generate or upload documents for a PCO, they are stored in the corresponding company's folder in Forma Data Management based on the PCO scope:

PCO Scope Documents Stored In
Out of Scope Owner company folder
Contingency Owner company folder
Budget Only Owner company folder
In Scope Main Contractor company folder

This folder mapping reflects the workflow logic: ‘In Scope’ work is the contractor's responsibility, so documents go to their folder. Out-of-scope, contingency and budget-only items require owner review, so documents go to the owner's folder.

Keep in mind:

Populate Pending Change Orders without an Open Subcontractor Change Order

When a general contractor already knows the proposed price, they can populate pending change orders without creating an RFQ. To do so, enter a proposed value in the Proposed column on a cost item level when creating a PCO. The value is shown in the Pending Change Orders column in the Budget table.

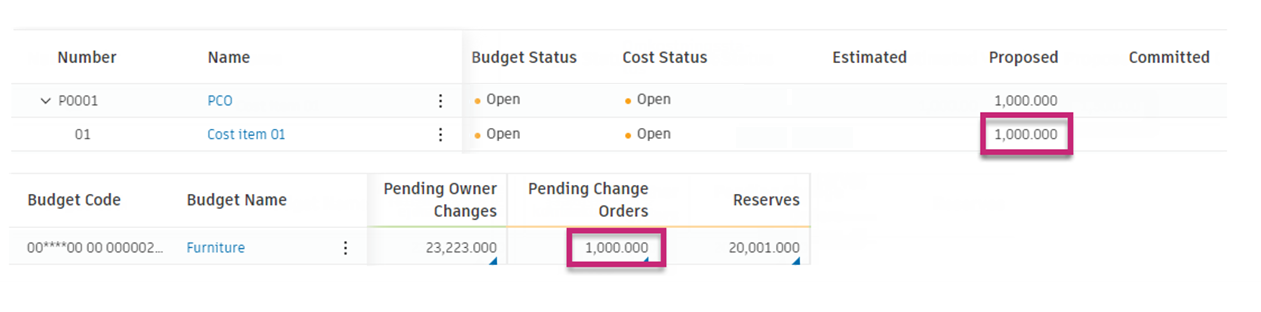

PCO without RFQ

Reconcile Pending Owner Changes in the Budget Table

When you set PCO budget statuses such as Submitted and Accepted, values roll into Pending Owner Changes in the budget overview. The default roll-up includes pre-submitted and submitted owner changes across scope.

The system Pending Owner Changes column shows the full pending total. A custom column such as Accepted Owner COR shows a filtered subset – for example, only Accepted owner changes. To show only Accepted owner changes in a separate budget column, an administrator first configures Manage columns in Settings. See Example: Reconcile pending owner changes with a custom column in Create Custom Columns for how to duplicate Pending Owner Changes, create custom project values and save an Accepted Owner COR column.

Submit and accept PCO budget statuses

Create or update potential change orders (PCOs) so budget statuses reflect your reconciliation scenario.

  1. Go to the Change Order tool and select PCO.

  2. Add PCOs (for example, COR 1 and COR 2) with the scope and values you want to track.

    PCO tab with two draft COR records

  3. Select the PCOs, open the More menu More menu icon, choose Budget change, then Set as Submitted.

    PCO More menu with Budget change and Set as Submitted options

  4. Set one PCO Budget Status to Accepted and leave others at Submitted (or your target statuses) using Budget change.

    PCO list with COR 1 Accepted and COR 2 Submitted budget statuses

Compare pending and accepted totals

After PCO statuses are set, compare totals in the Budget tool:

  1. Click the column settings icon and show your Accepted Owner COR column in the Budget group.

    Budget column settings with Accepted Owner COR selected to show in the table

  2. Compare Pending Owner Changes (full pending total) with Accepted Owner COR (accepted subset).

    Budget table showing Pending Owner Changes and Accepted Owner COR values side by side

  3. Click a cell with the audit history indicator (blue triangle) to open the cell details panel. Review linked cost items and PCOs.

    Budget cell details panel showing PCO links and audit history for pending and accepted owner change columns

Tip: Custom columns that use project values can show the audit history indicator when cell details are available. The flyout helps you compare change orders included in Pending Owner Changes with your custom Accepted Owner COR column. See View connected change orders in Work with Budgets.

Create an Internal Budget Transfer from PCO

Project administrators and members with both Budget and SCO full control permissions can create internal budget transfers directly from PCOs. This is useful when you need to move money from one budget item to another to pay for change orders without requiring extra approvals.

Tip: You can also create budget transfers directly from the Budget tool or from forecast adjustments.

To create a budget transfer from a PCO:

  1. Go to the Change Order tool and select the PCO tab.

  2. You can create a budget transfer in several ways:

    • From a PCO: Click the More menu Vertical more menu icon next to the PCO, click Budget change and select Transfer budget.
    • From multiple items: Select multiple PCOs or cost items, then click Transfer budget in the batch actions.

    Batch transfer budget example

  3. Then, in Internal budget transfer:

    • Each selected cost item with a non-zero Committed value creates one transfer line.
    • For positive Committed values (money allocated), the system automatically uses the cost item's linked budget in the To field.
    • For negative Committed values (money being removed), the system automatically uses the cost item's linked budget in the From field.
    • The Amount is automatically set to the absolute value of the Committed amount.
    • A note is automatically added referencing the source cost item.
  4. Click Add Icon to add more transfers, even those that are not linked to the cost items. Those transfers are separated in the table.

  5. Click Delete Icon to delete a transfer from the list.

  6. You can use Copy to all "From" or Copy to all "To" buttons to quickly populate all transfer lines with the same budget.

    Copy to all "From" buttons example

  7. Click Save to create one or more internal budget transfers.

You'll receive confirmation that the budget transfer was completed.

Generate a Contract from a PCO

Before generating a contract, make sure that:

Then:

  1. Click the More menu More menu icon next to the PCO.

  2. Choose Cost Change.

  3. Click Generate Contract.

  4. Enter Contract Code and Contract Name. If the foreign currency setting is enabled in your project, you'll see the Currency and Exchange Rate fields as well.

    • Choose the currency for your new contract.
    • Edit the exchange rate if needed. The default exchange rate is fetched from the settings.
  5. Enter the committed value or copy it from the cost item. If the foreign currency setting is on, the Converted icon icon shows the converted value.

  6. Click Generate.

Tip: Contract schedule of values will be generated from the Committed value and its breakdown of each Cost Item. If all cost items of a PCO have a status of Contracted or Approved, PCO cost status will move to Approved.

Apply a Financial Markup to a PCO

You can create financial markup formulas to be added to change orders. An example of a financial markup is an add-on such as a bond, contingency or fee. Before you can apply a financial markup, a project administrator must create the financial markup formula in the Change Order settings tab.

After the financial markup formula is created, you can apply it to PCOs. To do so:

  1. Switch to the Change Order tool.
  2. Select the PCO tab within the Change Order tab.
  3. Click the More menu More menu icon of the PCO that you want to add markup formula to.
  4. Go to Add Markup and select the financial markup formula to use.

Expand the PCO to see that the financial markup is added to the PCO.

If you see that your calculated markups are out of sync, select the line item and in the Apply Markup drop-down select the necessary markup from the list.

Note: If a PCO has no cost items and there is a value at the PCO level, you'll be prompted to add a cost item before applying markup. You have to add cost items before markup formulas can be applied.

Add Cost Items to a PCO

While you can create and work with PCOs without cost items for initial estimates, certain actions require cost items to be added. The system will guide you through adding cost items when needed.

Add cost items to a PCO before:

Adding Cost Items

When you select Add Cost Item from the More More menu icon menu, the system displays a modal to help you add cost items:

  1. Select budgets from the budget picker.

  2. Choose the cost items that you want to add to the PCO.

    Add cost item to PCO modal

  3. Click Add.

The first cost item that you add will inherit the value from the PCO level, and the default cost item name will be copied from the PCO name.

If you attempt an action that requires cost items (such as applying markup or generating a change order) without having cost items attached, the system will display a modal prompting you to add cost items first with the message "Cost Item must be added before [action name]" and guides you through selecting the appropriate budgets and cost items.

Tip: When adding multiple cost items, ensure that the sum of the cost item values matches the PCO level value to maintain data consistency.

Import Cost Items From a Spreadsheet

You can import cost items and sub-items into an existing PCO from an Excel spreadsheet instead of adding them one at a time. Create the PCO manually first, then import the cost breakdown.

You need Full Control permission for PCO and Cost Item to import cost items. Members with collaborative access and PCO create permission can also use this workflow.

To import cost items into a PCO:

  1. Select the Change Order tool from the left navigation.

  2. Select the PCO tab.

  3. Create a PCO or open an existing one.

  4. Click the More menu More menu icon on the PCO row and select Import Cost Item.

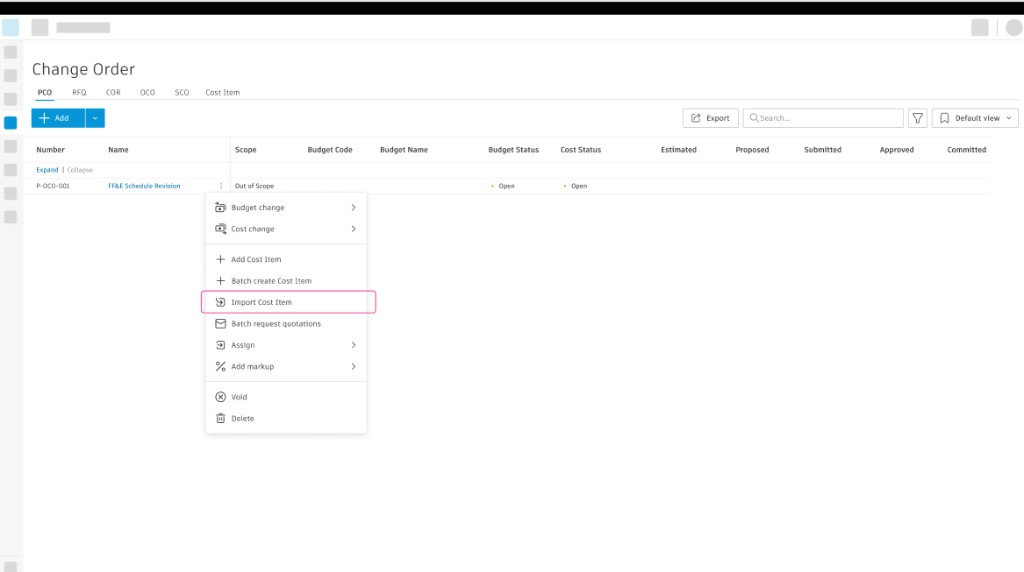

    PCO More menu showing Import Cost Item option

  5. On the Cost Item Import page, click Download template in the Notes panel.

  6. Fill in the template with cost items, sub-items, budget codes and estimated amounts. See Prepare the cost item import spreadsheet for formatting rules.

  7. Drag a file into the preview area or click Choose file to select your spreadsheet.

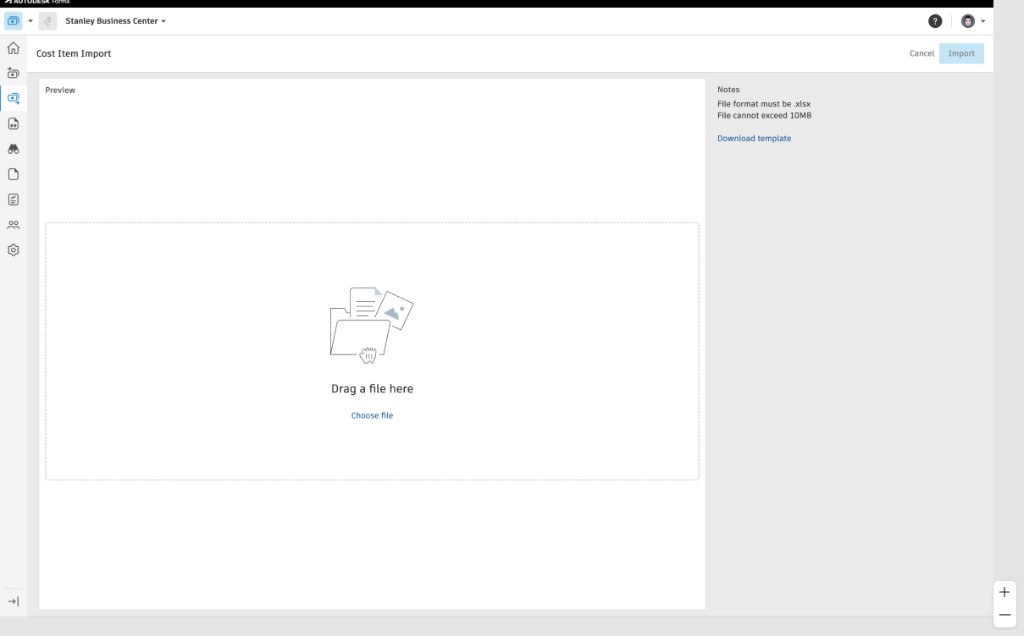

    Cost Item Import page with drag-and-drop area, Download template link and file requirements

    Note: The file must be in .xlsx format and cannot exceed 10 MB.
  8. Click Import.

Imported cost items and sub-items appear under the PCO. Amounts populate the Estimated column only. Update Proposed, Submitted, Approved and Committed values through the normal change order workflow.

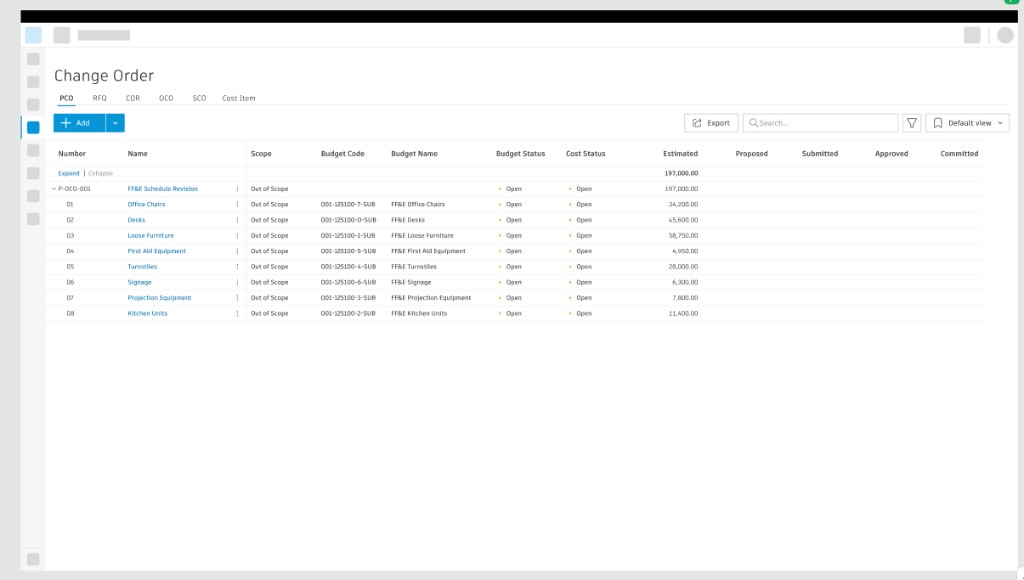

PCO table showing imported cost items, sub-items, budget codes and estimated amounts

Tip: You can import up to 200 cost items and 1,000 total lines per import. For larger datasets, import in batches.

Prepare the Cost Item Import Spreadsheet

The template includes example data and formatting rules in the Notes section.

Excel cost item import template showing columns, hierarchy example and formatting notes

Before you import:

Note: Do not modify cells highlighted in green (headers) or yellow (Budget Code header). The system recalculates Amount and Unit Cost on import to prevent rounding discrepancies. Cost item numbers are imported exactly as entered, regardless of number-formatting project settings. Duplicated cost items are allowed. Markup cost items, status values and Proposed, Submitted, Approved or Committed amounts cannot be imported.

If you leave the Budget Code column empty for a cost item, manually assign a budget code to that line after import.

Automatic Budget Code Linking

When you include budget codes in the import spreadsheet, the system automatically links each budget code to the corresponding cost item during import.

To use automatic budget code linking:

  1. Download the cost item import template from the Cost Item Import page.
  2. Fill in the Budget Code column for each parent cost item row in your spreadsheet.
  3. Import the completed spreadsheet.

The system matches each budget code to the appropriate cost item. After import, you can verify the budget code associations in the PCO table or cost item details panel.

Note: If a budget maps to multiple contracts, select the linked contract manually after import.

Export a PCO Report

You can export a PCO report that will contain all details or a minimum number of them. To do so:

  1. Select the Change Order tool from the left navigation.

  2. Switch to the PCO tab.

  3. Click Export Export button.

  4. Add the report title.

  5. Choose one of the following:

    • PDF Report – to export a report in a non-editable PDF format.
    • Excel Report – to export a report in an editable Excel format.
  6. Choose the report template:

    • Current View – you can export a report from the current view, for example with applied filters.
    • System Default Report – you can export a report with all default columns.
  7. Choose whether you want to include the cost item information in the report. By unselecting this option, you can export a report only with the minimum details.

  8. Add an optional message.

  9. Click Run report.

You’ll receive the report by email. You can also find and download it from the Reports tool.

Reports for collaborative access users

Users with collaborative access are able to export reports from change order tables (PCO/RFQ/COR/OCO/SCO).

Note: The access rights to each table are determined by permission settings.

For change order reports, cost items and their amounts, such as proposed amounts in RFQ reports, are displayed. However, budget codes and names are not included in these reports.
