The Expense tab enables teams to manage internal and external expenses. Enter invoice and approval information. Then the system updates actual cost data for more accurate forecasting. Expense data can also update budget payment applications.
In this article:
You need full control permission for the Cost tab to create expenses. Those can be added:
To add a list of expenses from an existing spreadsheet:
In the Cost tool, select the Expense tab.
Click .

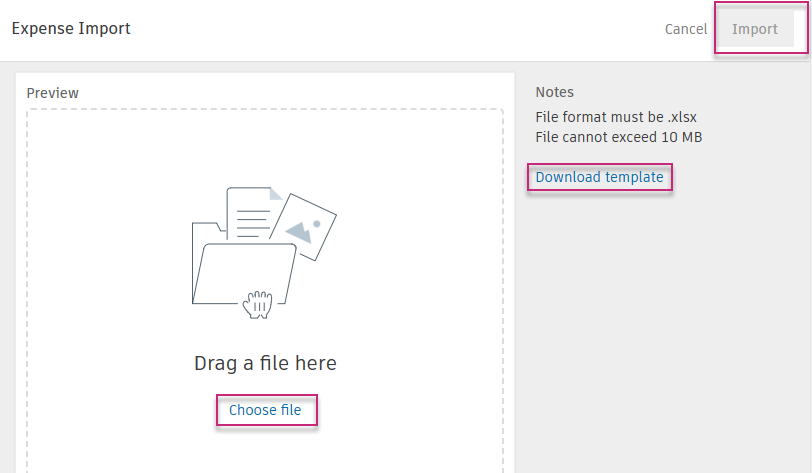

Choose an Excel file to be imported.
Click Import and then Done.
To add expenses from an existing contract:
In the Cost tool, select the Expense tab.
Click Add from Contract.

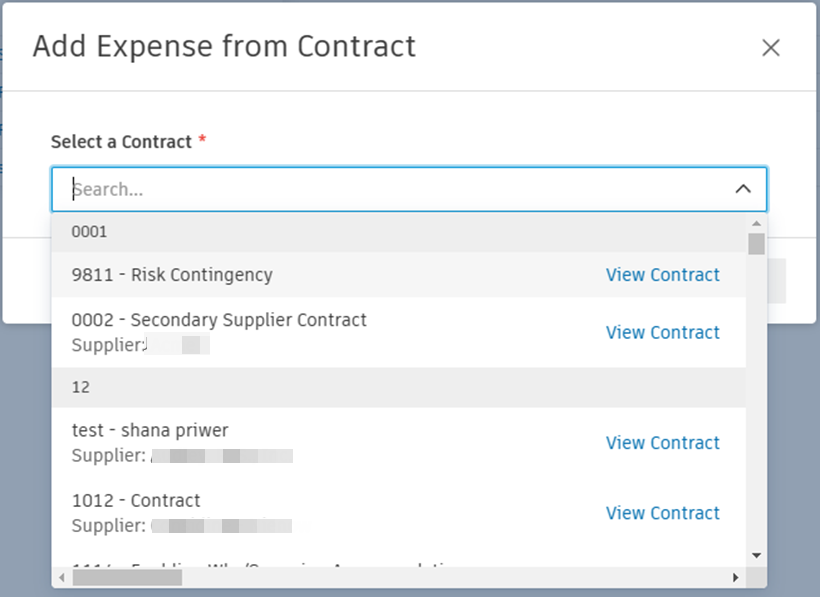

Select a contract with the drop-down list and click Add.
Fill in the following fields:
Expenses can also be entered and managed in foreign currencies. When a linked contract is awarded in foreign currency, you'll see the changes in the Expense tab. The system will automatically recognise the currency set for a supplier within their contract, so the Unit Cost and Amount are entered in the local currency. The system will auto-convert it back to the project’s base currency. Hover over the icon to see the converted values and the current exchange rate.
You can change the exchange rate by clicking the icon or the flyout panel of the expense, except at In Review or Paid status. Once an expense is approved the field will be locked and rate can’t be changed. Learn more about expense statuses.
You can add expenses manually. To do so:
Navigate to the Expense tab (described in the previous example).

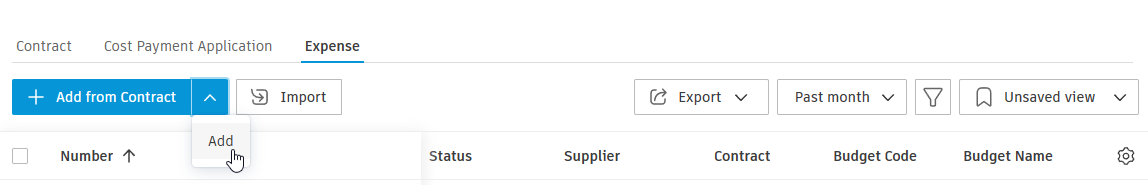

Select Add in the drop-down list.
Enter the following information:
Select Add Subitems from the More menu .
Enter the following information:
Set the status of the expense item to Open in the details panel.
Items and subitems can be deleted through the More menu .
Use the photo reference capability for expenses to ensure supplemental information such as delivery tickets or receipts are available to process payments.
To add a photo reference:
Within the Cost tool in Cost Management, navigate to the Expense tab.

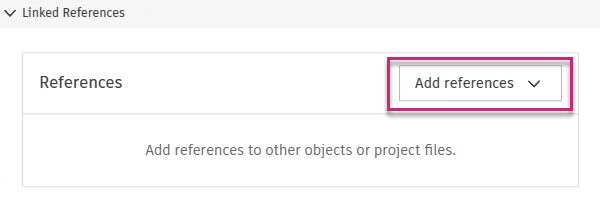

Select an expense item to open the flyout panel, scroll to the Linked References section and select Add References.

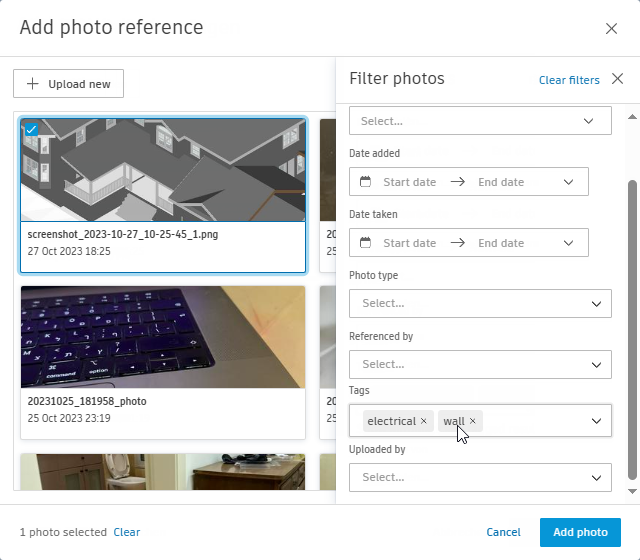

Existing photos from the Photos tool in Autodesk Build will appear in the Add Photo Reference window. To upload a new photo, select Upload New.
Choose the files from your desktop or drag and drop.
Select Upload, and then Add Photo.
You can use filter to quickly find specific photos. Select the funnel icon to access filters including location, date added or taken, photo type, referenced by, tags, and uploaded by.
Learn how to take the photos on iOS and on Android, and tag them on Mobile.
After you fill in the information for your expense item, you can submit it and send an email to reviewers. An approval workflow is an extra step in the expense workflow. See the Approval Workflow article to learn more.
After adding an expense:
Similar to approved cost payment application details pulling into the budget summary, approved or paid expenses automatically pull into the budget summary view, giving you the ability to view actual cost breakdowns and make accurate forecast adjustments.
To see the expense details in the Budget table:
In the Budget tool, navigate to the Budget tab.

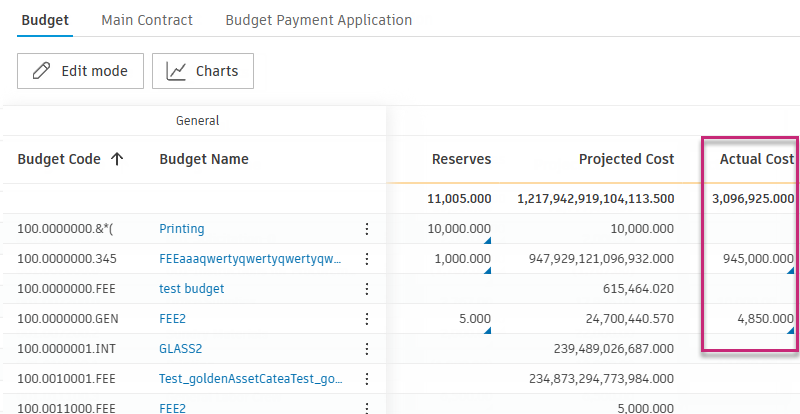

Scroll to the Actual Cost column. Expenses with an approved or paid status will be displayed in the list.

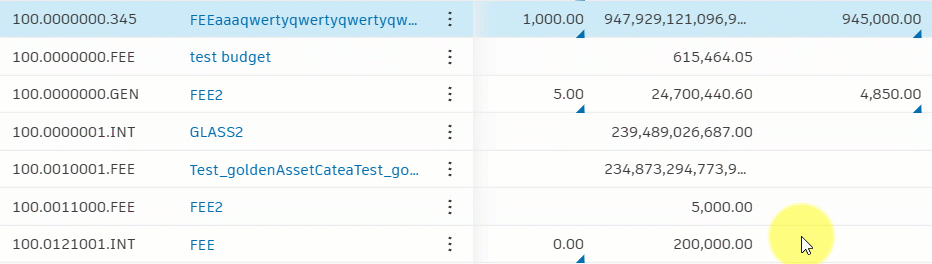

Select the total in the Actual Cost column to view the cost breakdown.
Click the budget name to open the flyout panel for more detailed information.
See the Budget and Contract Tables or Work with Budgets articles to learn more about working with the Budget tool and its table views.
You can add expenses manually to a budget payment application to track them and show liability against the budget.
To add an expense:
Select the Budget tool.
Select the Budget Payment Application tab.

Use the contract and date drop-down lists to navigate to the appropriate budget payment application.
Select the main contract name to open the details panel.

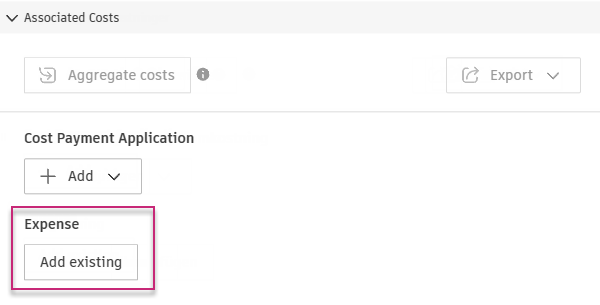

Click Add existing in the Associated Expense section.
Select the appropriate expenses to associate.
Click Add.
To detach expenses, select the More menu of the expense row.
When adding expenses to a Budget Payment Application, you have two aggregation options: Aggregate by Qty and Aggregate by Amount.
Default Aggregation Method: The system determines the default aggregation method based on specific criteria:
If all these conditions are met, the system will automatically set the expense to Aggregate by Qty. This is often preferred when aggregating quantities like payroll hours, especially when there’s a difference between internal unit costs and selling prices to the owner.
You can easily filter the existing expenses on your list by time range to quickly get the information you need. This feature can be useful when exporting a report. Please note that this view won't be added to saved views.
To add a time range filter:
Select the Cost tool from the left navigation.
Switch to the Expense tab.
Click the Past month drop-down list, next to the Export one.
Select one of the following predefined options:
Alternatively, you can choose a custom range by clicking the ‘Custom range’ option. This will allow you to select a start and end date for the expenses you want to see.
You can delete expense items or subitems using the More menu . To delete an expense item or subitem, the status must be Draft, Pending, Revise and Resubmit, or Rejected.
Learn more about statuses in the expense workflow:
To create a formatted report of the list of expenses:
Select the Cost tool from the left navigation.
Switch to the Expense tab.
Click .
Choose between PDF Report and Excel Report.
Enter the report title and choose the report template:
Current View – includes all currently visible columns. Use this one to create a report for filtered budget table views or previously saved current views.
System Default View – includes system default columns in all groups.
Click Run report.
You'll receive an email notification when your report is ready to download. You can also download it from the Reports tool. To learn more about reports and available actions, see the About Reports article. See the Cost Reports article to review all available reports for Cost Management.
