Payments

With the payment application workflow, you can manage payment applications effectively, automate tasks and gain a real-time view of the project’s financial health. As a project administrator, you can create payment applications in the Budget and Cost tools to send to an owner or a supplier.

To effectively work with payments:

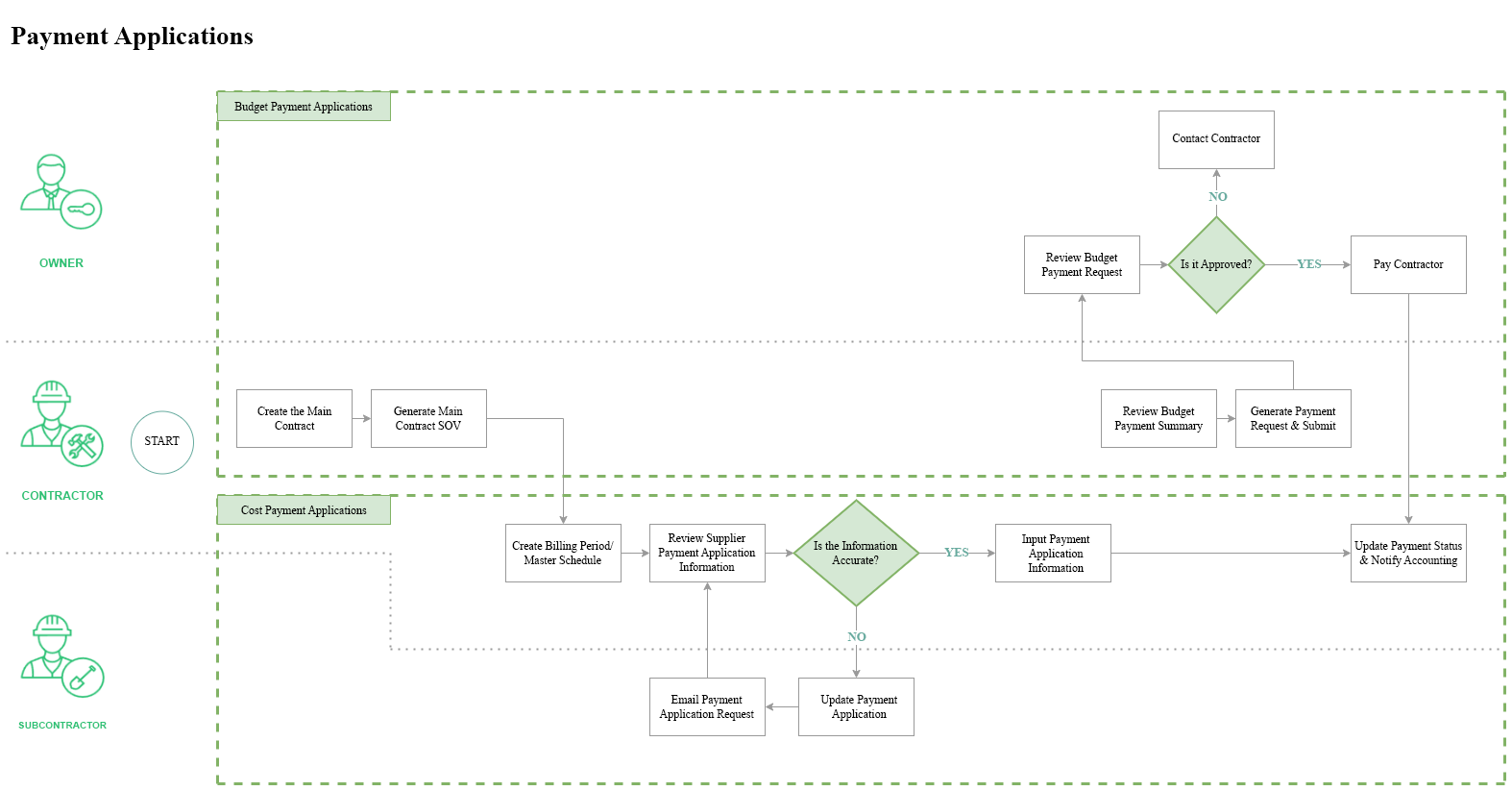

Check out a typical workflow for requesting and receiving payments:

In this article:

Payment Application Tables, Sections and Columns

The tables in the Budget and Cost Payment Application tabs contain the following sections:

The values populate and move across the columns in the Budget and Cost Payment Application tabs. Hover over a column to see the logic behind it. Click the gear icon to see all available columns.

Here is a handful of helpful examples:

Note: By default, payment applications can't exceed the value entered in the budget or contract. To change it, allow overbilling from the More menu .

Cost Payment Application Detailed View

The Cost Payment Application tab offers a list view of every cost payment application for your project. However, it also has a detailed view, where you can review the info on any listed item. To see this view, click the icon next to a payment item.

In the detailed view of a cost payment application, you can, for example:

Learn more about cost payment application-related actions.

Foreign Supplier Payment Application Management

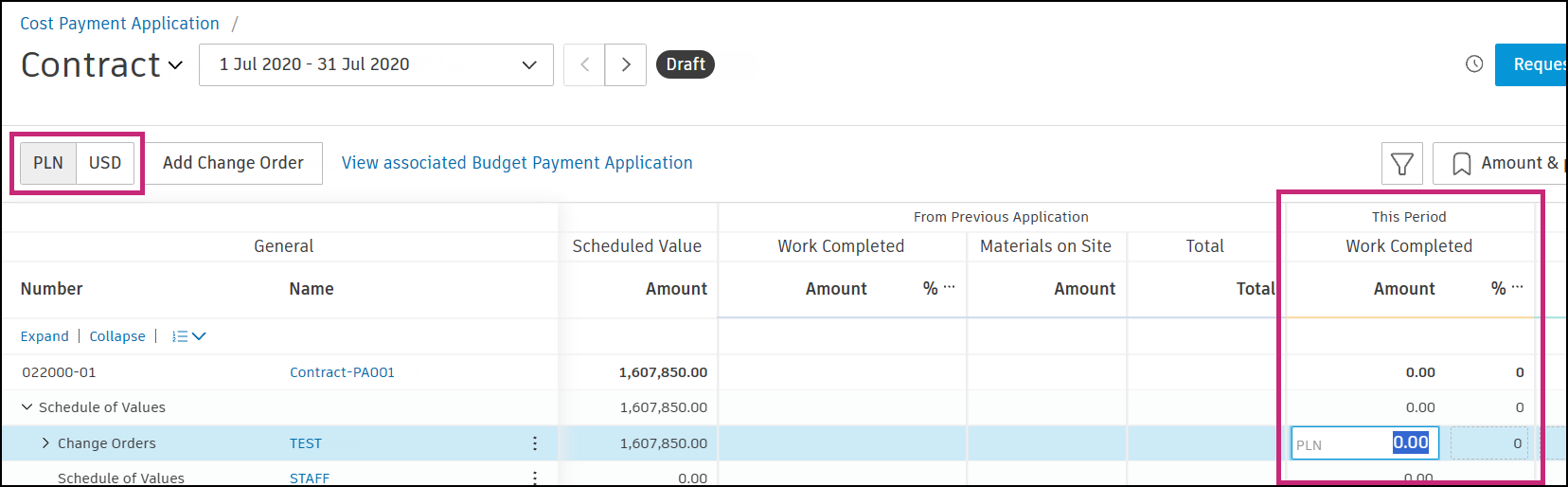

Payment applications can also be entered and managed in foreign currencies. Set up a foreign currency on the contract and associate it with the cost payment application. Within the Cost tool, select the Cost Payment Application tab and open the details view for the appropriate supplier. Now you can send it to your foreign suppliers.

In the cost payment application's list view, the values are shown in the base currency. Hover over the icon to see the converted values and the current exchange rate. To edit the exchange rate:

  1. Open the detailed view of the cost payment application.
  2. Click the name of the cost payment application to open the flyout.
  3. Edit the exchange rate. It can be edited at any time except at the In Review, Paid, or Approved status. Learn more about payment application statuses.

In the detailed view of the cost payment application, you can:

The system will automatically recognise the currency set for a supplier within their contract, so Work Completed will be entered in the local currency. And the system will auto-convert it back to the project’s base currency.

Note:

  • If overbilling is disallowed, the validation process will only apply to the foreign, not base currency values.
  • When you set a cost payment application's status as Approved, you can edit the exchange rate. After doing that, this application and the Actual Cost values will be recalculated. The next applications will be updated as well.

Advance payment and recoupment

The advance payment feature enables members to configure, create and manage advance payments and their recoupment in construction projects. An advance payment is a partial payment that is made before the work has started or the goods have been delivered, usually to cover some initial costs such as procurement of materials or equipment. The feature aims to facilitate the management of advance payments and reduce the risks associated with them.

In Cost Management tables, there are several columns related to Advance Payment:

Table Column Section
From Previous Application Advance Payment Amount
Recoupment Amount
This Period Advance Payment Amount
% of Scheduled Value
Recoupment Amount
% of This Period Work Completed
This Application Total Advance Payment Amount
% of Scheduled Value
Total Recoupment Amount
% of Total Advance Payment
Remaining Unrecouped Advance Payment Amount
% of Total Advance Payment

Add Advance Payment

To add an advance payment:

  1. Open the Cost Payment Application.

  2. To enable the Advance Payment-related columns, click the column gear button.

    Now, you have two options:

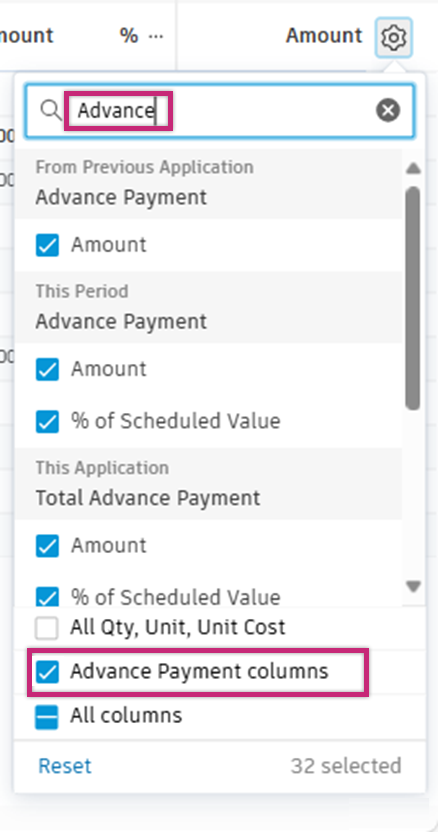

    • Search for the Advance keyword in the column search area.

    • Select the Advance Payment columns in the Columns Groups section.

  3. Input the advance payment as either an amount or a percentage.

  4. The system will automatically update the Total Advance Payment amount field in This Application column.

Note: The advance payment and recoupment columns can only be enabled on the line items mode.

Progress payments with recoupment

Recoupment is a repayment of advance payment through deductions from progress payments. You can choose which payment items are applicable for recoupment.

To add recoupment amount or percentage:

  1. Open the Cost Payment Application.
  2. Navigate to the column labelled This Period and Recoupment within it.
  3. Input the recoupment as either an amount or a percentage.
  4. The system will automatically update the Total Recoupment amount field in This Application. The Total Recoupment is calculated as the sum of Previous Recoupment and This Period Recoupment.

When members create another pay application, it automatically inherits recoupment percentage from the previous pay app, but does not inherit the recoupment amount.

Note: By default, collaborative access users can't modify recoupment related columns. If primary users are Owner, the system will automatically enable collaborative access users to modify advance payment and recoupment related columns.

Payment application summary

The Total Advance Payment and Total Recoupment amounts are included in the Payment Application summary, which is visible in the flyout panel in the Cost Payment Application.

To show the Summary:

  1. Open the Cost Payment Application.
  2. Click the selected payment application.
  3. Flyout panel, including the Payment Application summary pops up.

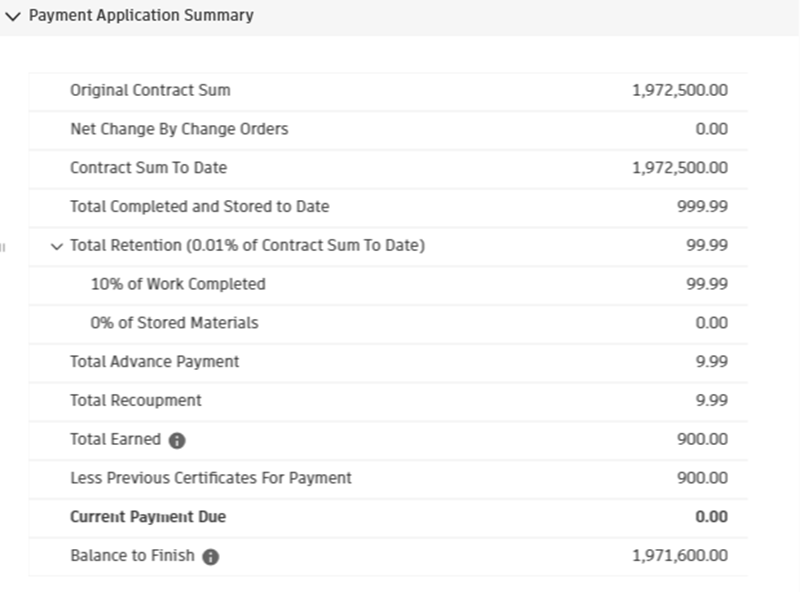

The summary includes Total Earned, which excludes retention and includes unrecouped advance payment and a Balance to Finish, which includes retention but excludes unrecouped advance payment.

Overbilling

Overbilling in Autodesk Cost Management occurs when the billed amount exceeds the budgeted or contracted amount for a specific item or service. This can lead to discrepancies and potential disputes between project stakeholders. To ensure accurate billing, it is essential to check for overbilling in your payment applications.

Steps for overbilling checking:

  1. Go to the Budget or Cost tool in Cost Management.

  2. Switch to the Budget Payment Application or Cost Payment Application tab. For a cost payment application, open the detail view by clicking the icon next to it.

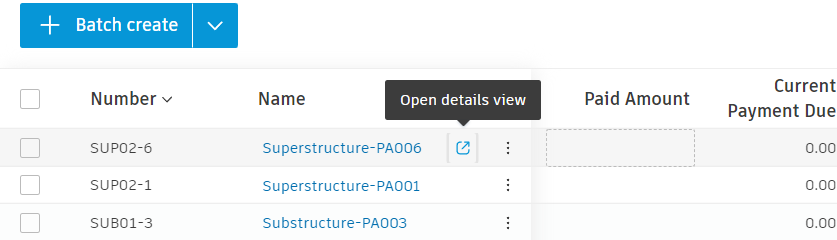

    Open details view

  3. Select between Line items and Column view modes to identify where overbilling occurs.

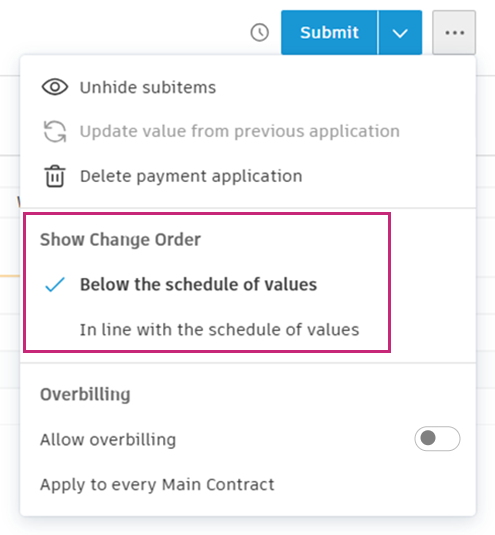

    Show change orders as

    Note: Overbilling may appear in one view mode but not the other. Always review the payment application in both view modes. For example:

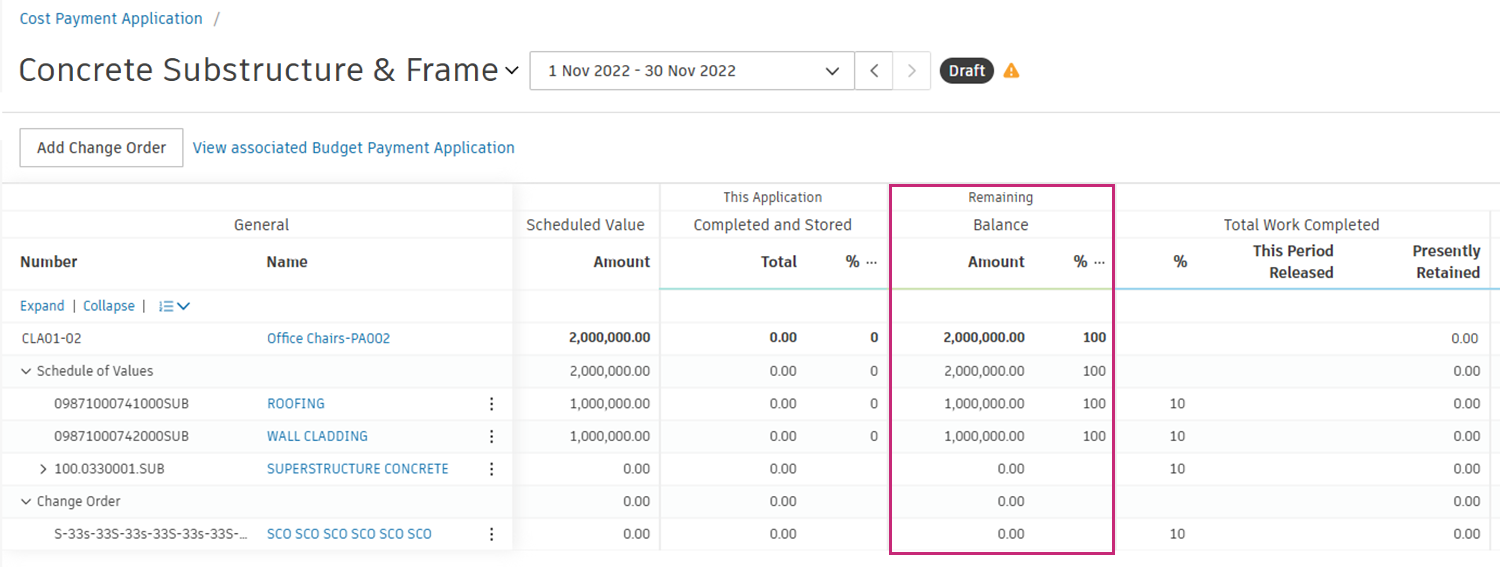

    • Due to negative change orders, there may be no overbilling item in line items view mode:

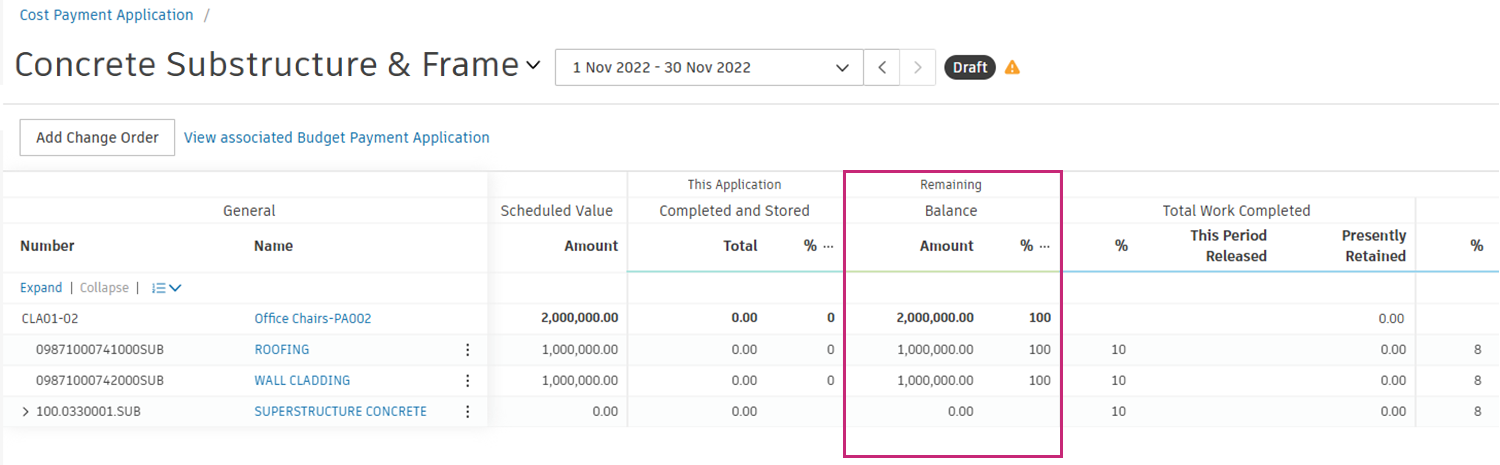

    • However, there may be overbilling items in column view mode:

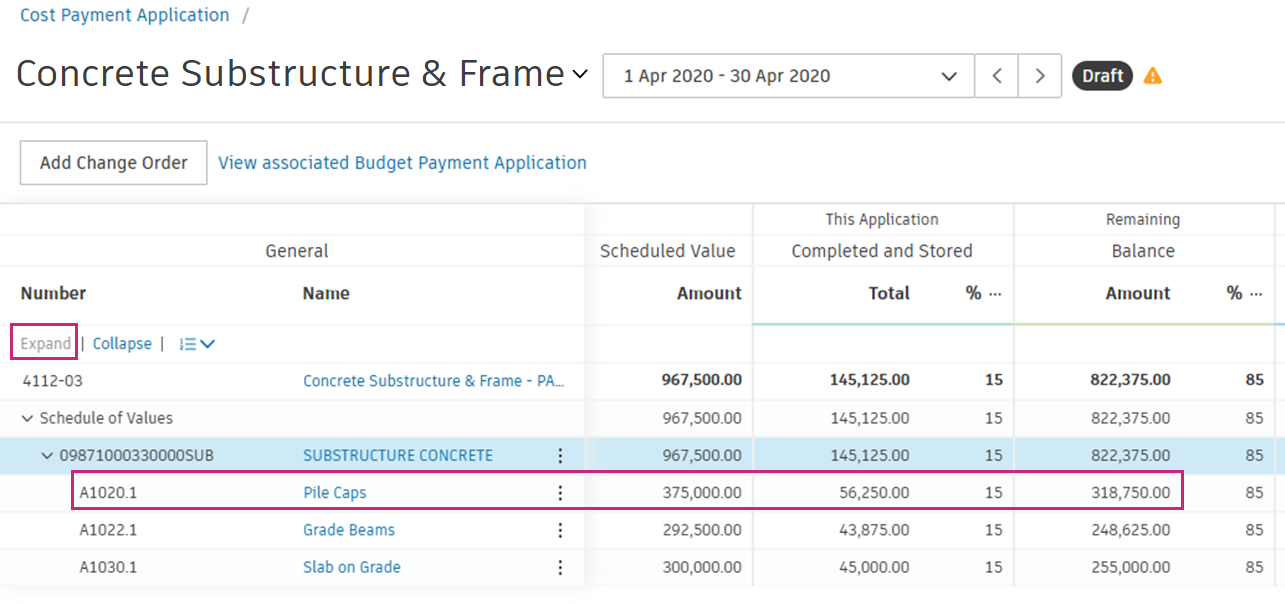

  4. Expand the SOV (Schedule of Values) tree structure to view all items. Overbilling checking will iterate through every child item in the SOV tree structure.

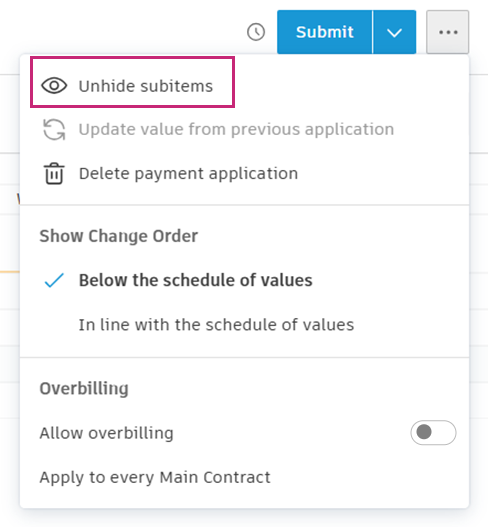

    • Tip: For budget payment applications, it also checks hidden SOV subitems. If you receive an overbilling error message, unhide any hidden subitems to identify the overbilling items accurately.

Tip: Overbilling checking is most accurate in line items view mode, so avoid submitting payment applications from the list view.

By following these steps and tips, you can effectively manage overbilling and maintain accurate billing throughout your project's lifecycle.

Frequently Asked Questions about Payments
