Retention is a portion of payment held back from contractors to ensure work is completed satisfactorily. This article explains how retention works in Cost Management.
In this article:
Retention, also known as retainage, is a standard construction industry practice where a percentage of payment is temporarily withheld from contractors and subcontractors. This holdback typically ranges from 5–10% of the payment amount and serves several important purposes:
In Cost Management, retention can be configured at the project level and customised for individual contracts. The system automatically calculates retention amounts during the payment application process based on your specified rates for completed work and stored materials. As the project progresses towards completion, retention funds can be partially or fully released according to contract terms and project milestones.
Retention management is a critical aspect of construction financial administration that helps maintain project financial health while balancing cash flow needs of all parties involved.

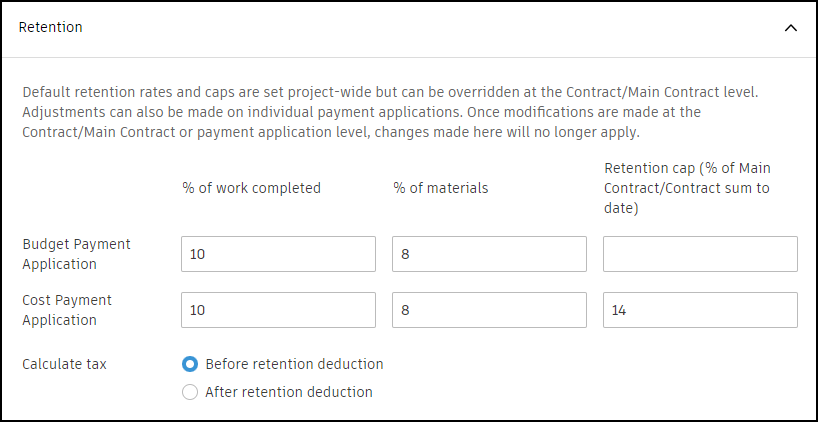

To set the retention rates:
When a retention cap is applied to the contract or main contract, members with Full Control permission will see this information in the cost and budget payment applications details view.
It's possible to establish a retention rate for a project based on a percentage of completion. To illustrate, consider a scenario where the retention rate is set at 10%, but it is limited to 5% of the total project value. On a contract worth 1,000,000 USD, distributed evenly across five months, 200,000 USD of work would be invoiced and 20,000 USD retained each month. However, by the 3rd month, the cap would be reached, as the retention can't surpass 50,000 USD.
To learn how to release the retention, see Retention Release.

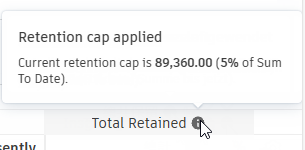

When the Total Retained amount is bigger than the retention cap amount, you'll have options to adjust the exceeded retention cap.
If you choose to:
Retention release is the payout of retained funds to contractors or subcontractors after meeting milestones, such as project completion, and passing required inspections and approvals.
Members with Full Control permission, and project administrators, can toggle the Enable retention release option. Project administrators can also adjust retention settings in General Settings.
This option is disabled by default for new payment applications. If the option is disabled:
This Period Released columns in Retention Total Work Completed and Retention Materials Stored (Materials Billed) show 0 and are uneditable.
Changes to Total Work Completed Retention % affect only This Period Work Completed Retention.

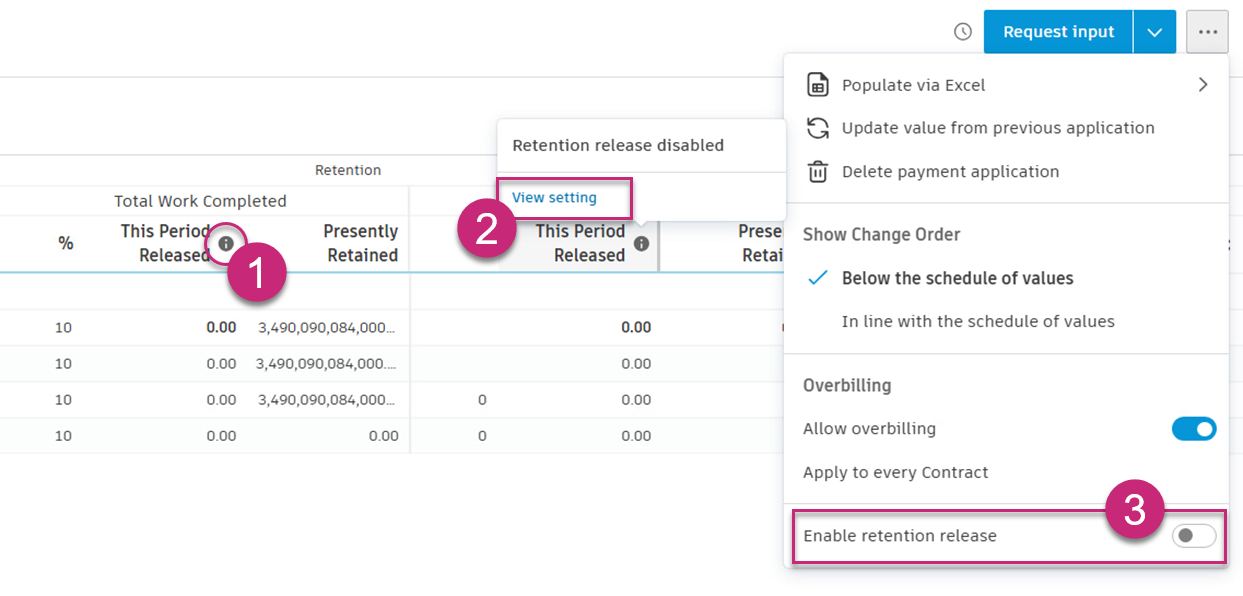

A message in the column header displays: ‘Retention release disabled.’ A link to settings is provided. You can click it to enable retention release for this payment application:
Steps to release retention for a payment application:
If the option is enabled:
To bill for retention, create a billing period and a new payment application. Then release all retained amounts or adjust the retention percentage to zero.
Question: Is there a way to bill for retention under the same billing period?

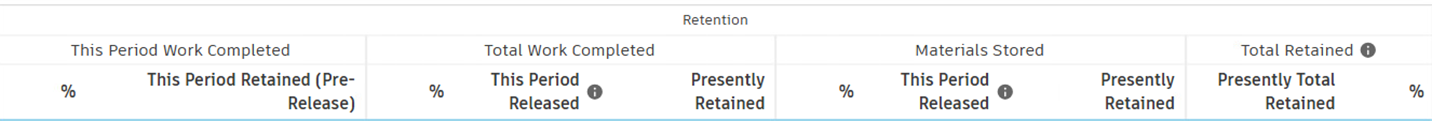

Yes, you can bill for retention within the same billing period. To do this, manually update the retention amount or percentage for each payment item in the payment application for the current billing period:
Go to the Cost Payment Application or Budget Payment Application tab.
Within the current billing period, adjust retention columns by clicking the icon.

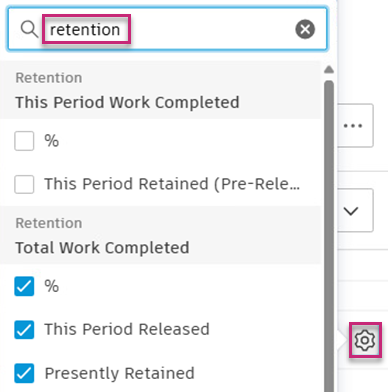

Type ‘Retention’ and choose the corresponding retention-related columns.
Manually adjust This Period Work Completed Retention Percentage to the desired percentage for each payment item that you want to apply for retention.
