Approval workflows are a key feature of Cost Management, designed to streamline the approval process for:
By creating custom approval workflows, project administrators and members with full control permissions can streamline document routing for internal reviews, ensuring consistency and transparency across projects. For instance, a change order workflow can automatically route the document to the project manager, accounting department, and owner or supplier for approval. This automation offers several benefits:
In this article:
Only project administrators can create and edit approval workflows. To create one:
Select the Settings tool
from the left navigation.
Switch to the:
Click the relevant drop-down menu depending on the type of approval workflow that you want to create:

Click Create Approval Workflow.
Select the number of approval steps, and click Next.
Enter a name for the workflow.
Set conditions using drop-down menus to activate the workflow automatically. For example, activate when the approved value exceeds $10,000. Conditions vary by workflow type.

Assign reviewers for each step. For each step, you can:
Add a step name (for example, Internal Review).
Set reviewer type (single or multiple). Specify if all members must review or set a minimum number.
Determine response due time.
Choose reviewers (member, role, or company). Reviewers must have Full Control or Admin permissions.
Decide if reviewers can edit items under review.

Add up to 12 steps per workflow. Click Remove step to delete one.
Optionally, set the status upon completion to Submitted, Accepted, or Approved.
Click Save.
For budget payment applications, you can create multiple approval workflows based on different conditions, such as the main contract being used. This allows you to have different approval processes for different main contracts within the same project.

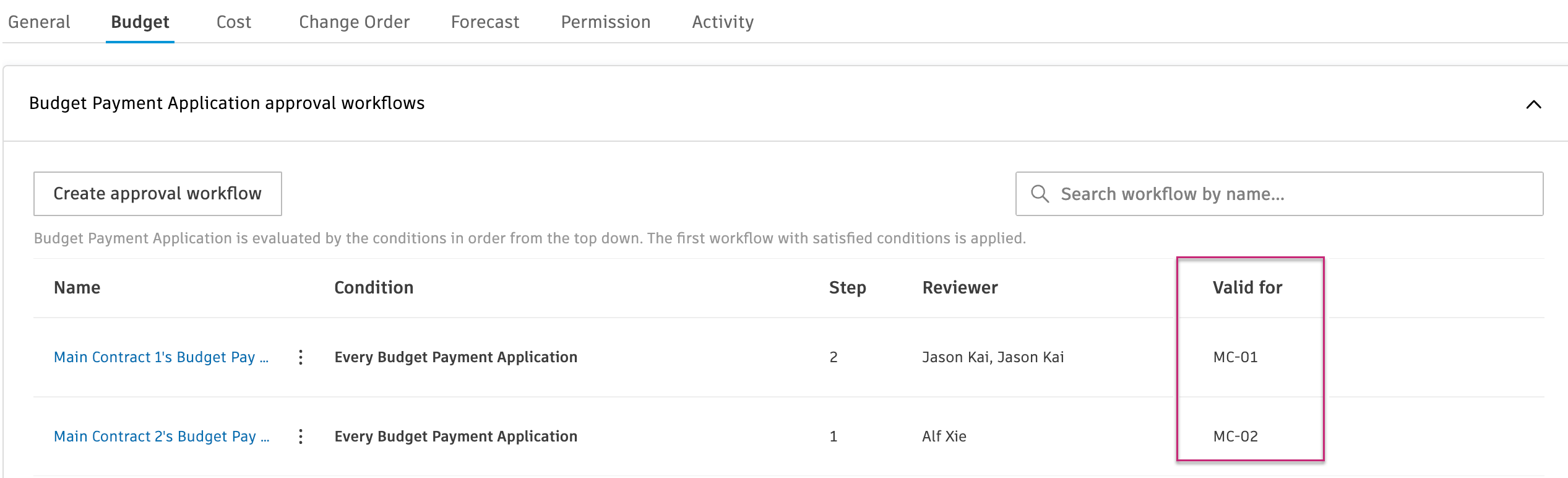

Budget payment applications are evaluated by the workflow conditions in order from the top down. The first workflow with satisfied conditions is applied to the payment application. The Valid for column in the workflow list shows which main contract each workflow applies to.

To configure a workflow based on main contract:
Follow the steps in Create Approval Workflows to begin creating a budget payment application workflow.

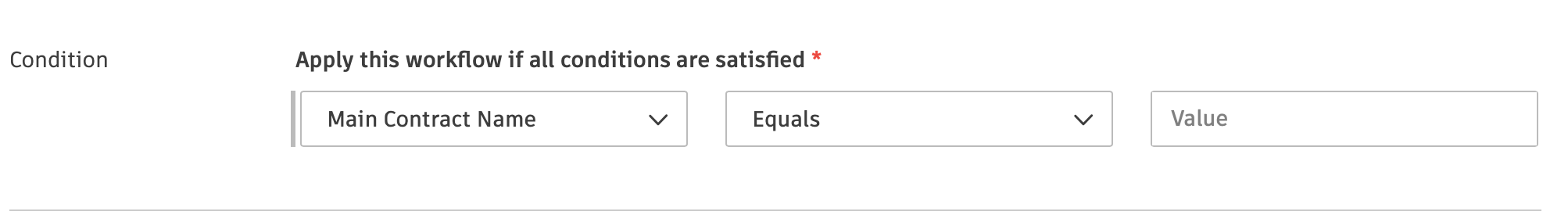

When setting conditions (step 7), select Main Contract Name from the first condition dropdown.
Select Equals from the operator dropdown.
Enter the main contract value in the Value field (for example, MC-01 or MC-02).

Complete the remaining workflow configuration steps and click Save.
The Valid for column will display the main contract code, making it easy to identify which workflow applies to which contract.
Project administrators can modify workflows by navigating to the relevant tab and approval section as described in steps 1-3 of the previous section. Then:
Expand the relevant workflow drop-down menu.
Select the More menu
and choose:
Project administrators can edit reviewers directly in the workflow bar in the flyout:
next to the name.
When an item meets workflow conditions, a dialog box appears, detailing the workflow and allowing comments.

As the item progresses, reviewers are notified through email.

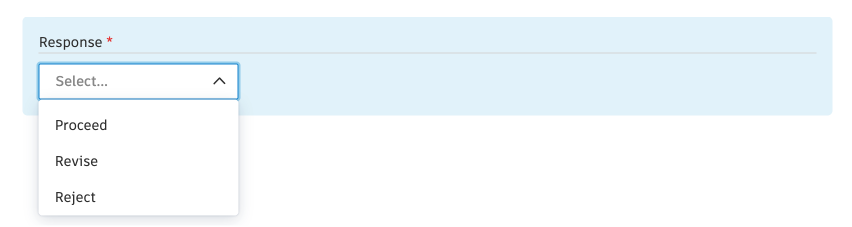

Reviewers can:
When approved, the final reviewer submits the item for external approval and signature. The workflow bar in the details flyout panel displays the item's status, ball-in-court, and due date. Activity is logged in the item's activity log.
The following restrictions apply when items are In Review:
| Item Type | Restrictions |
|---|---|
| Expense Items | - Subitems cannot be added or deleted. |
| - Expense items cannot be deleted. | |
| - Attachments can still be uploaded. | |
| - Photo references can be edited. | |
| Payment Applications | - All fields are locked. |
| - Reviewers can review payment applications by individual line items. | |
| - The parent line item is accepted only when all subitems are reviewed and accepted. |
