Cost Management

Settings

E-Signature Adapter – Using a common setup and workflow, Cost Management now supports direct integrations with multiple customer-preferred e-signature tools: DocuSign, SignNow, and Adobe Sign. A Dropbox Sign integration is currently in development.

Learn more about E-Signature Integration.

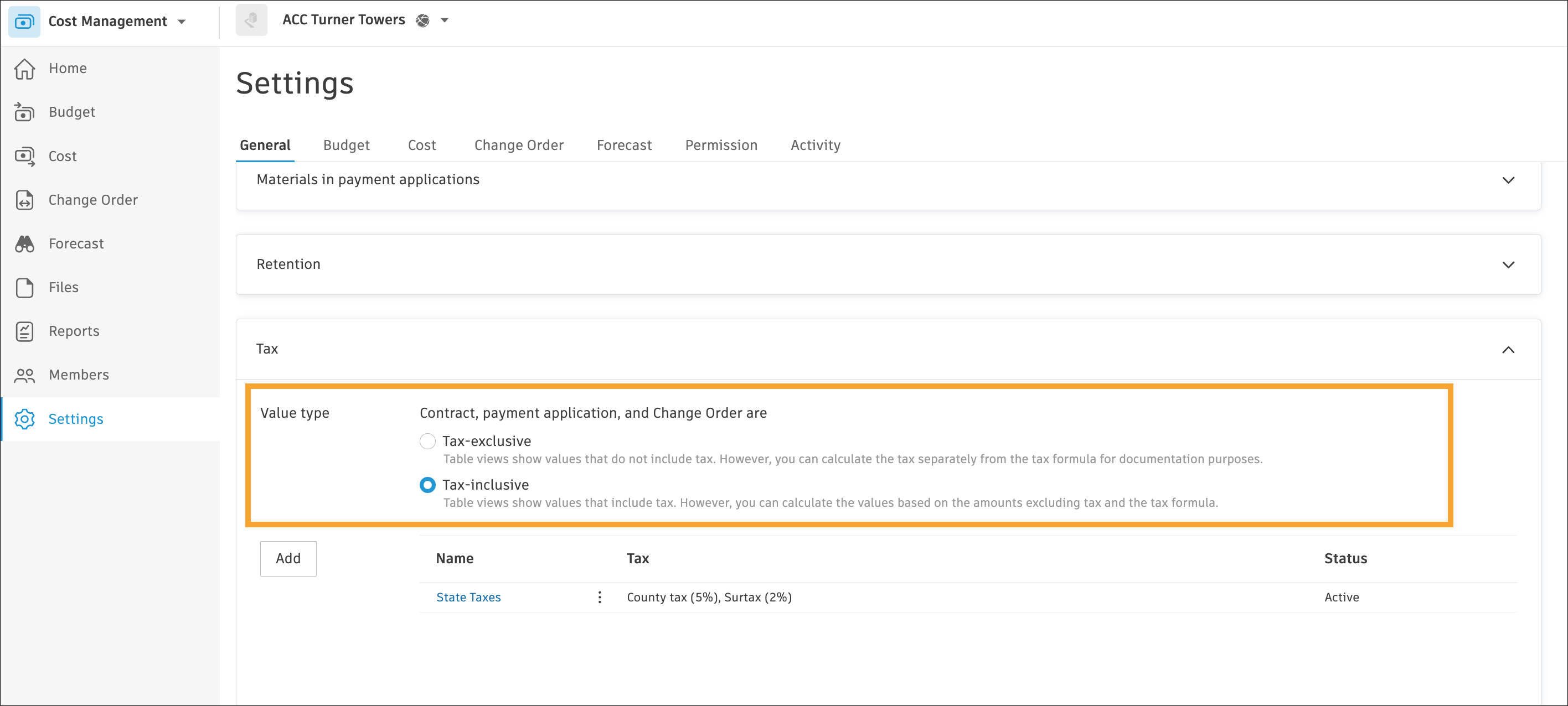

Inclusive Tax – To support countries where tax is deemed to be inclusive in Cost Management tables, there is a new Value type option in Settings > General > Tax.

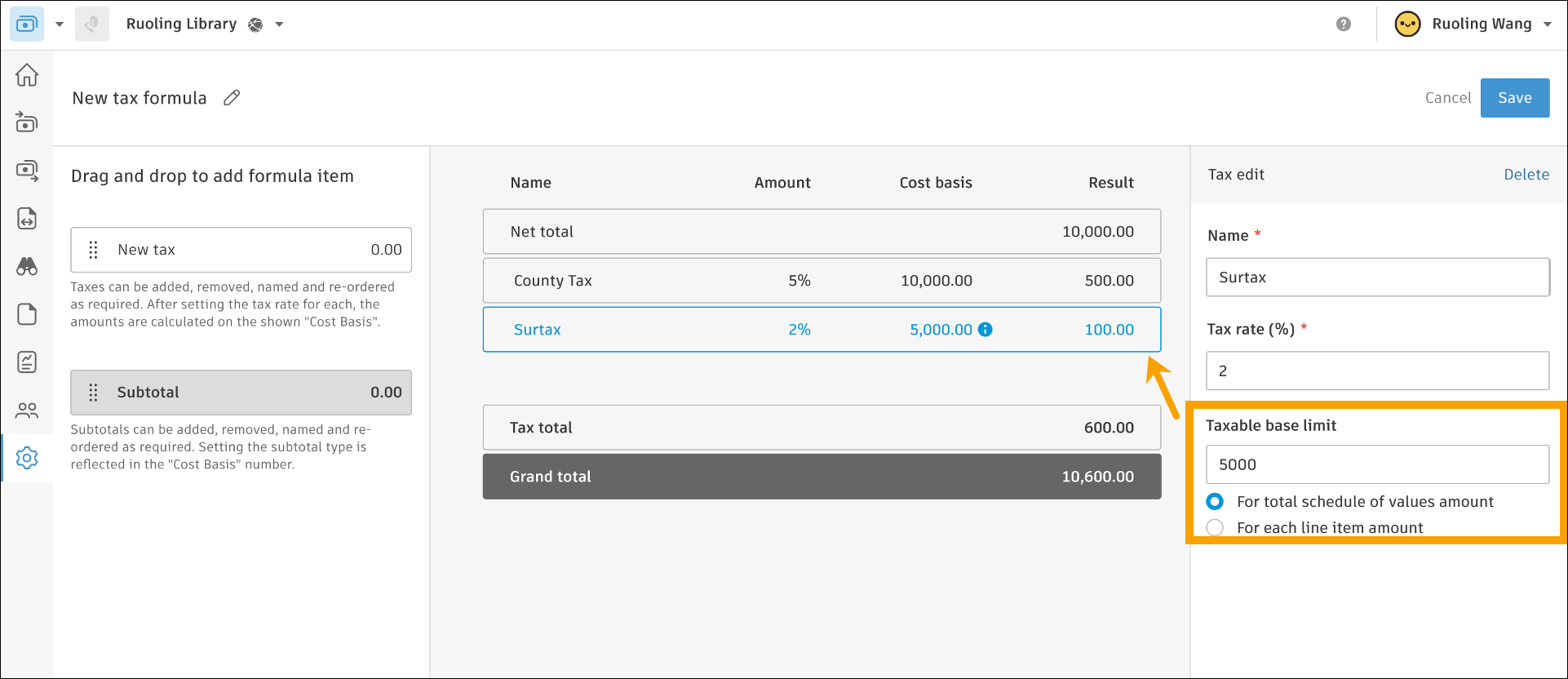

Capped Tax Calculation – Capped tax is set when creating a tax formula. Administrators have the option to set a taxable base limit for the total schedule of values amount or for each line-item amount. By default, the taxable base limit field is blank.

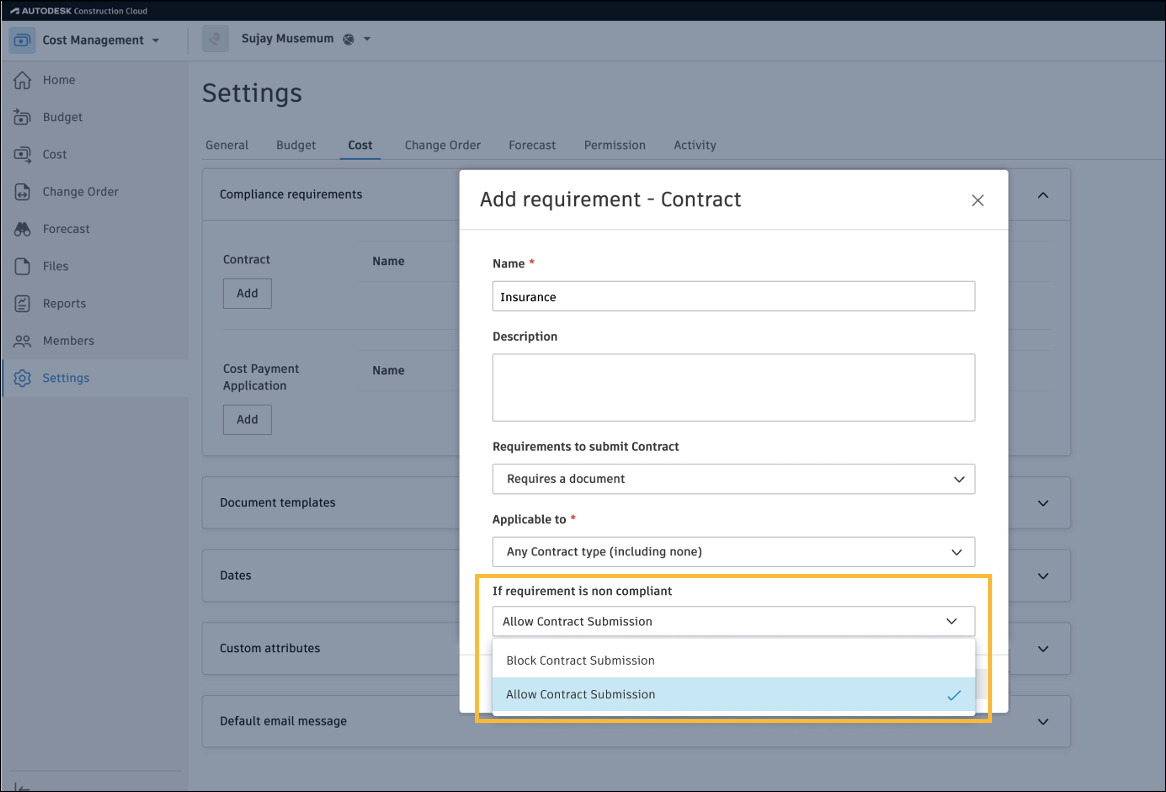

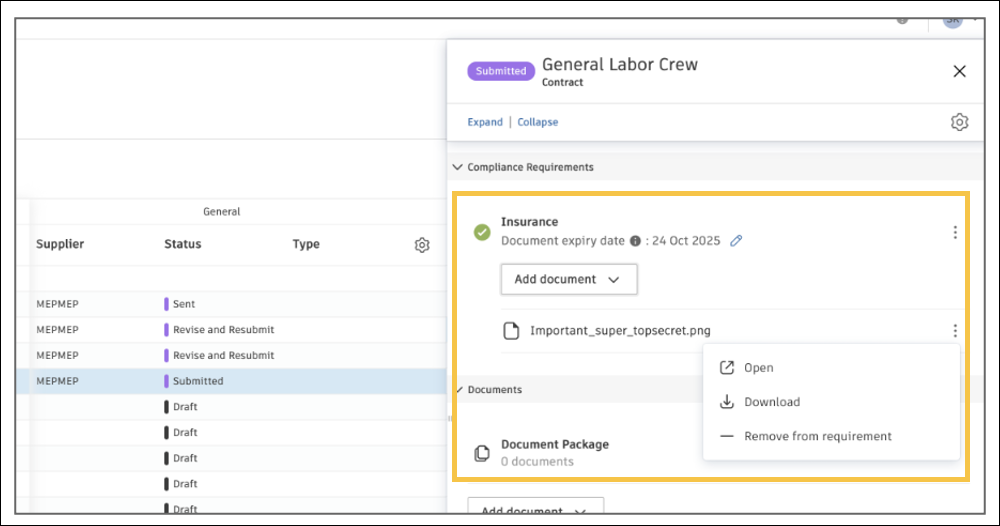

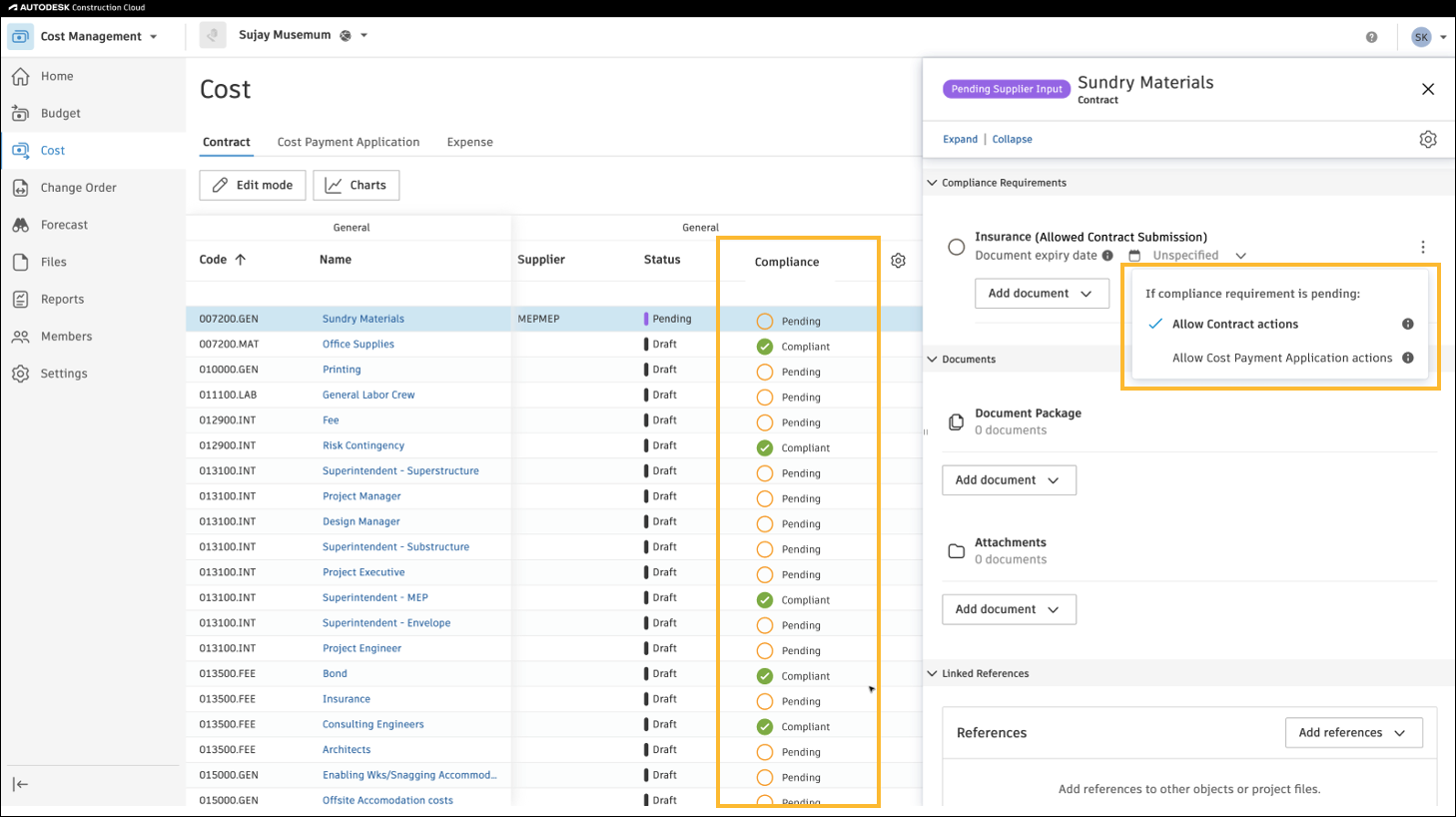

Contract Compliance Requirement Enhancements – To support greater flexibility the following enhancements have been added to contract compliance requirements:

Learn more about Compliance Requirements.

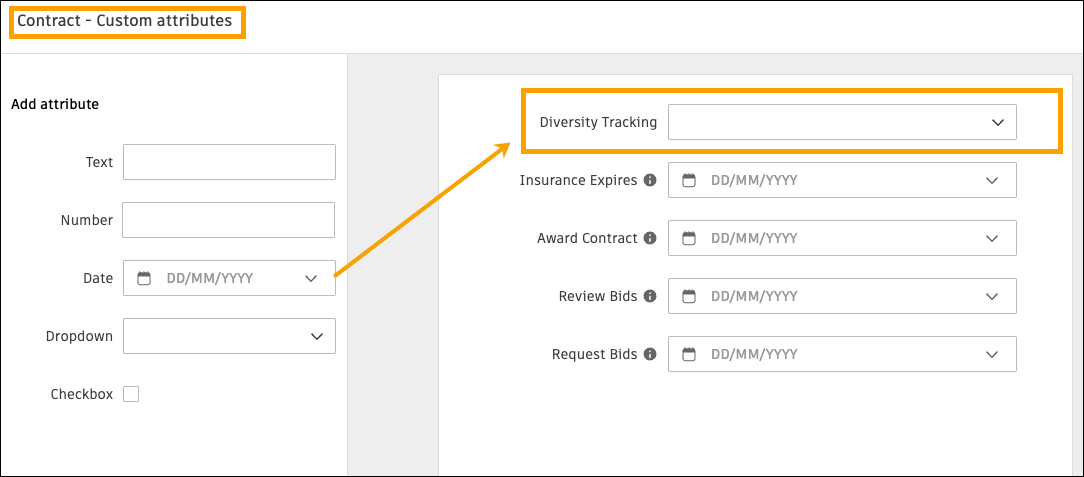

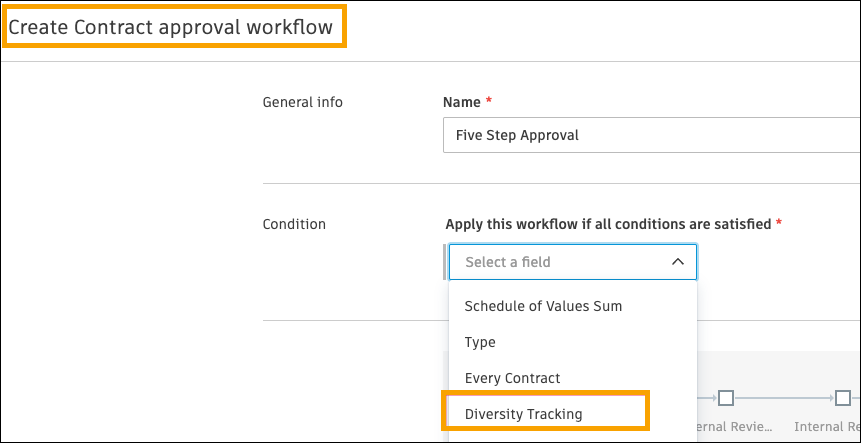

Approval workflow enhancement – The following custom attribute types can now be used as a condition to route Approval workflows: text, number, dropdown, checkbox.

Learn more about Approval Workflows.

Written Currency Variable Formatting – The system now automatically detects whether the conjunction 'and' should be included in currency variables. For example, in USD, 'and' is always excluded before 'dollars,' while in GBP, 'and' is always included before 'dollars.'

Budget Snapshots – Project Template Enhancement – Budget Snapshot schedules are now inherited from the project template when creating a new project with a template.

Budget Tool

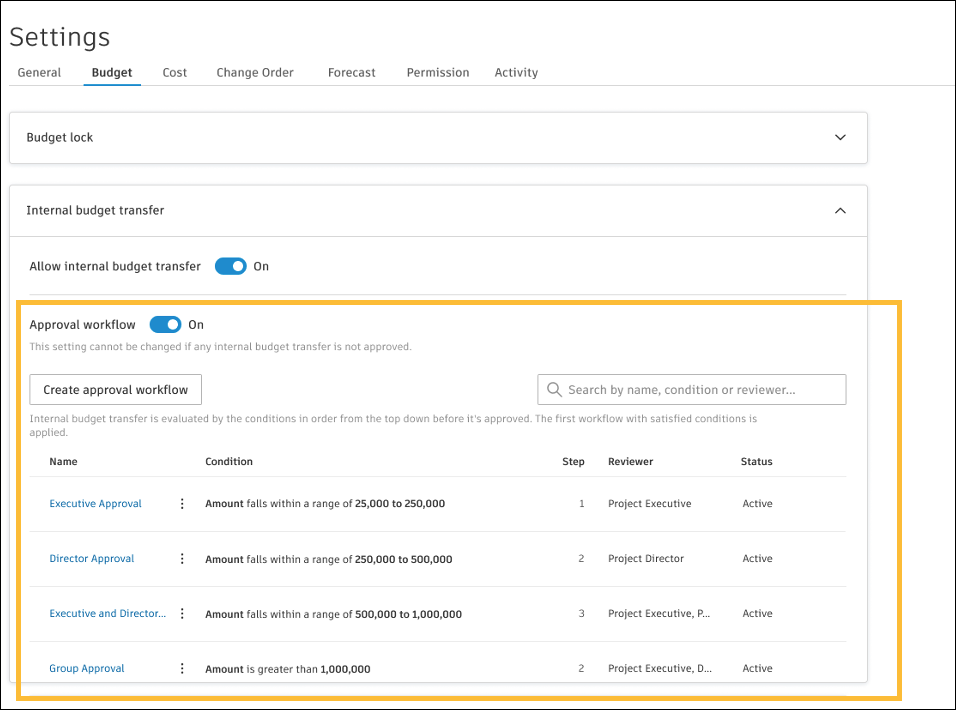

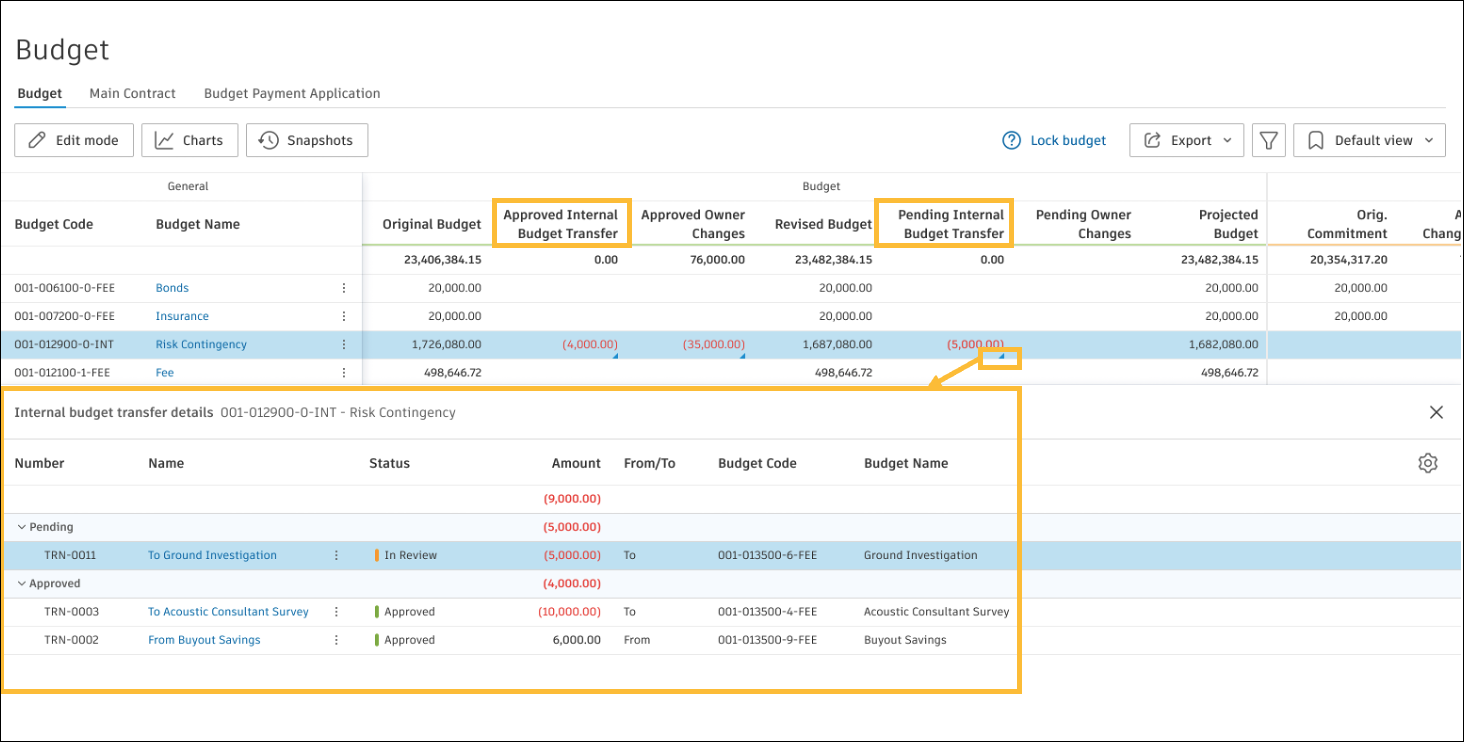

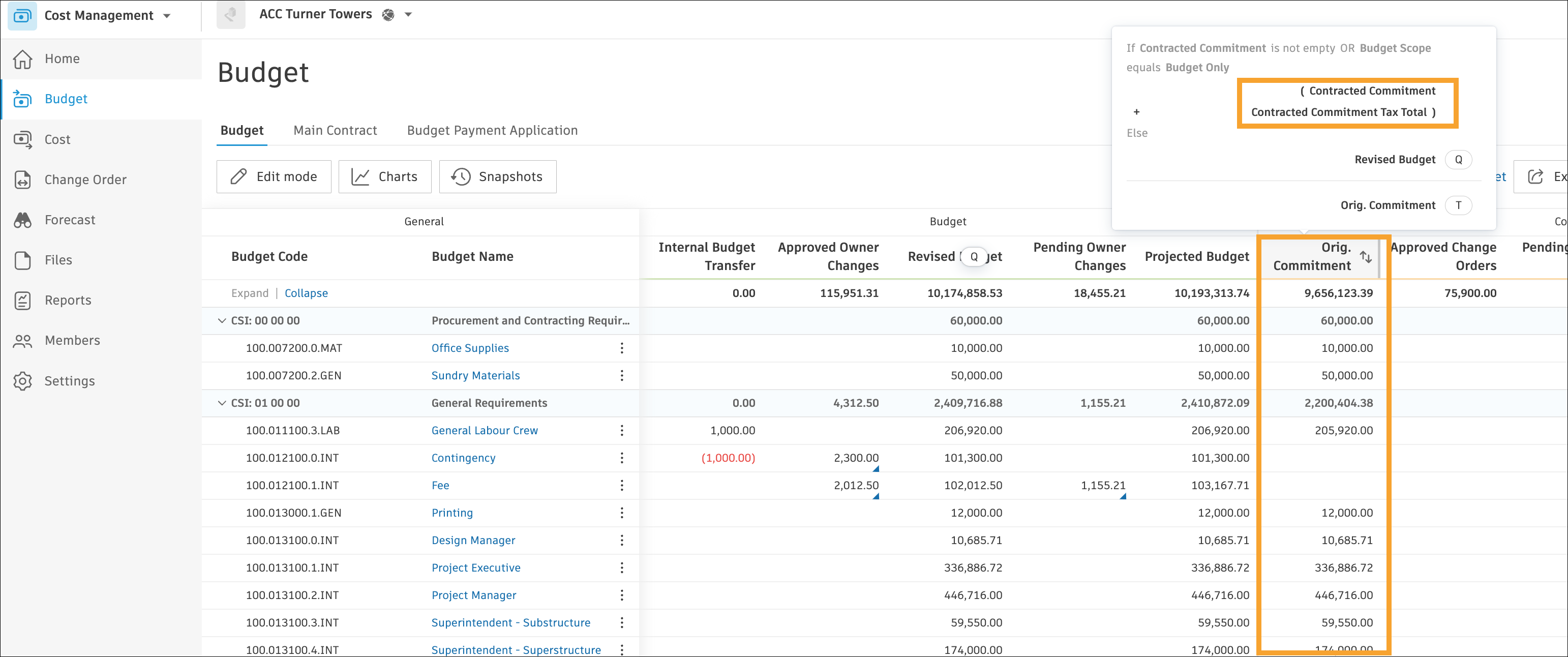

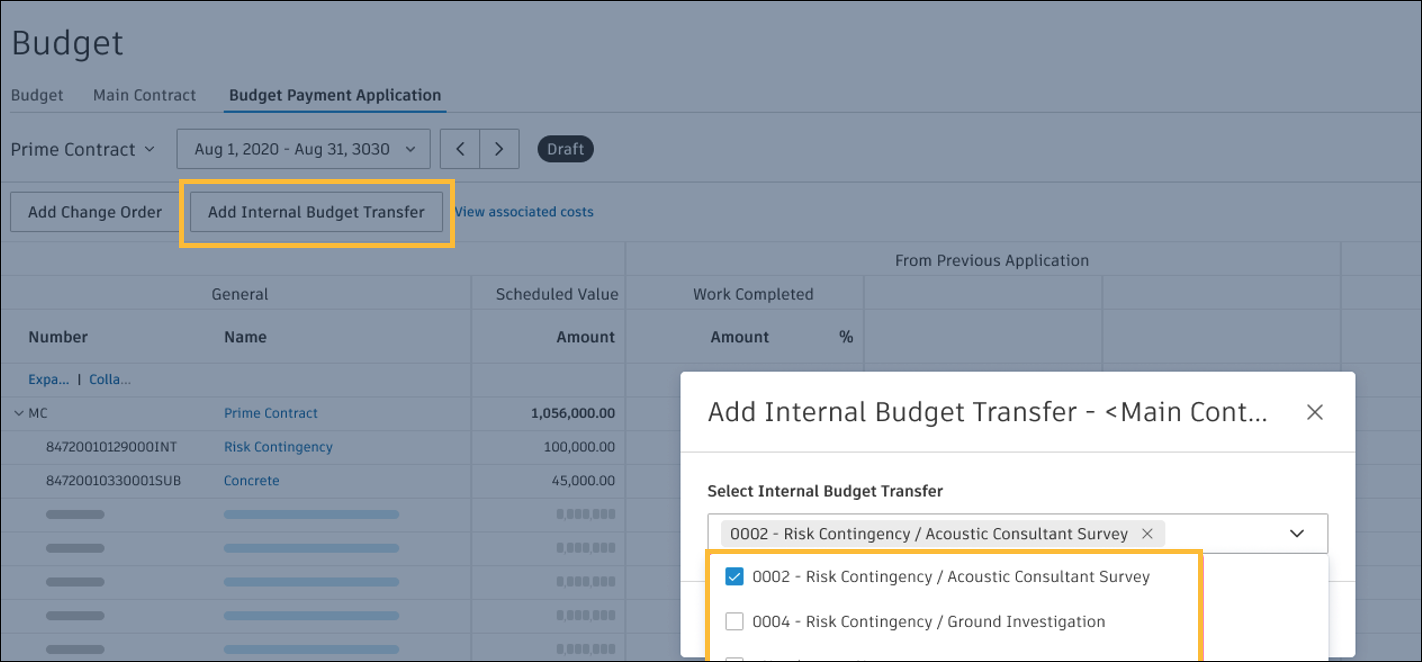

Internal Budget Transfer Enhancements – To offer greater flexibility, a new setting allows budget transfers to affect the Main Contract without going through a formal Owner Change Order process and have associated internal approval workflows if required.

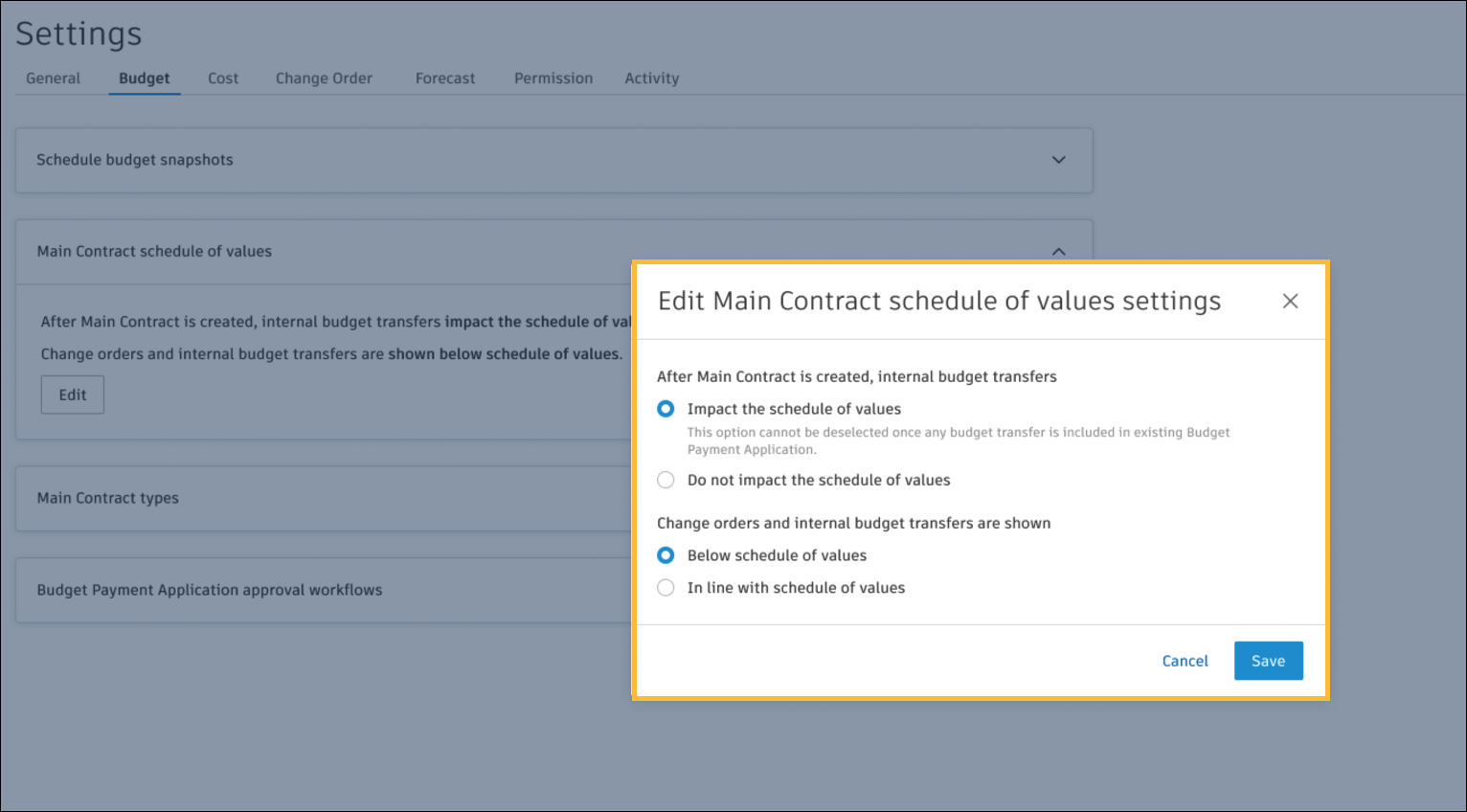

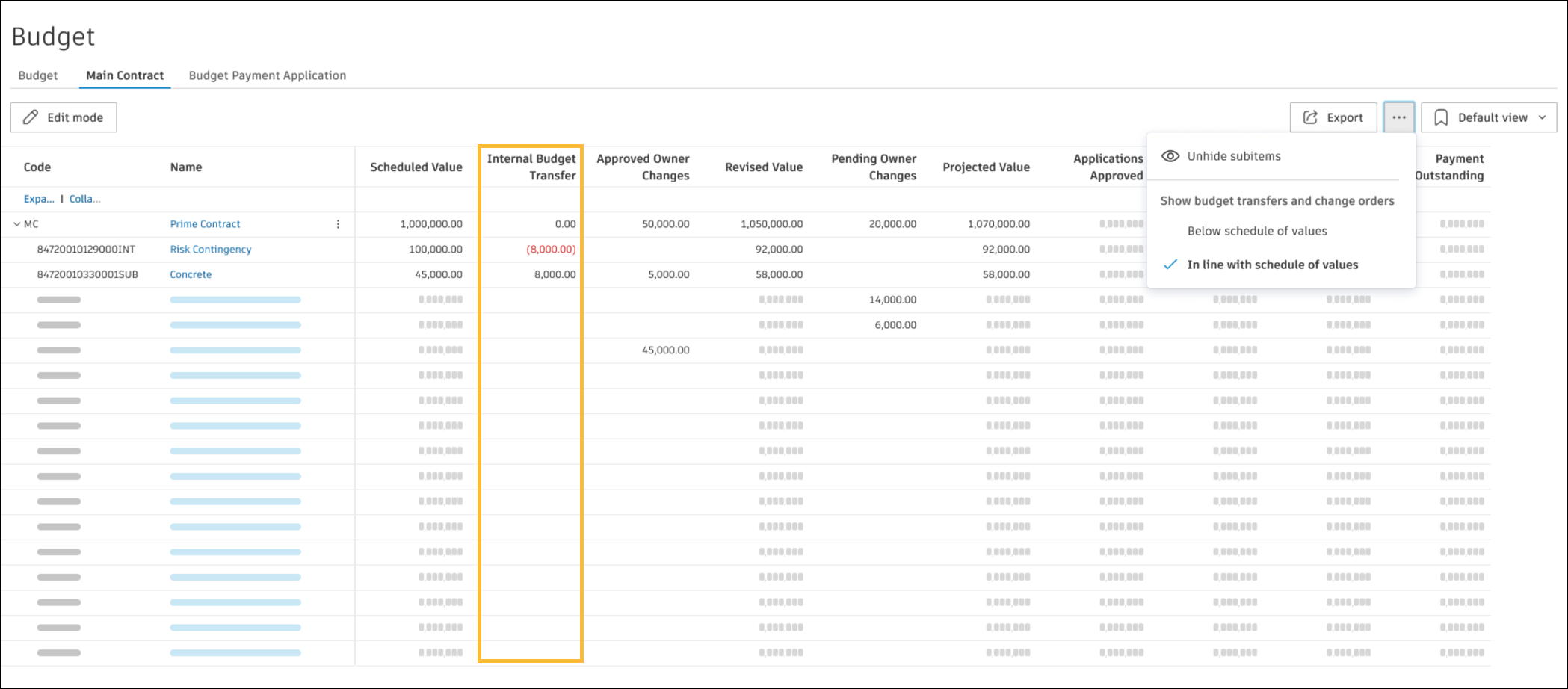

Contract SOVs Integration State Enhancement – When the integration state is locked and the Contract schedule of values is set to Amount locked, the system now allows processing of the Schedule of Values.

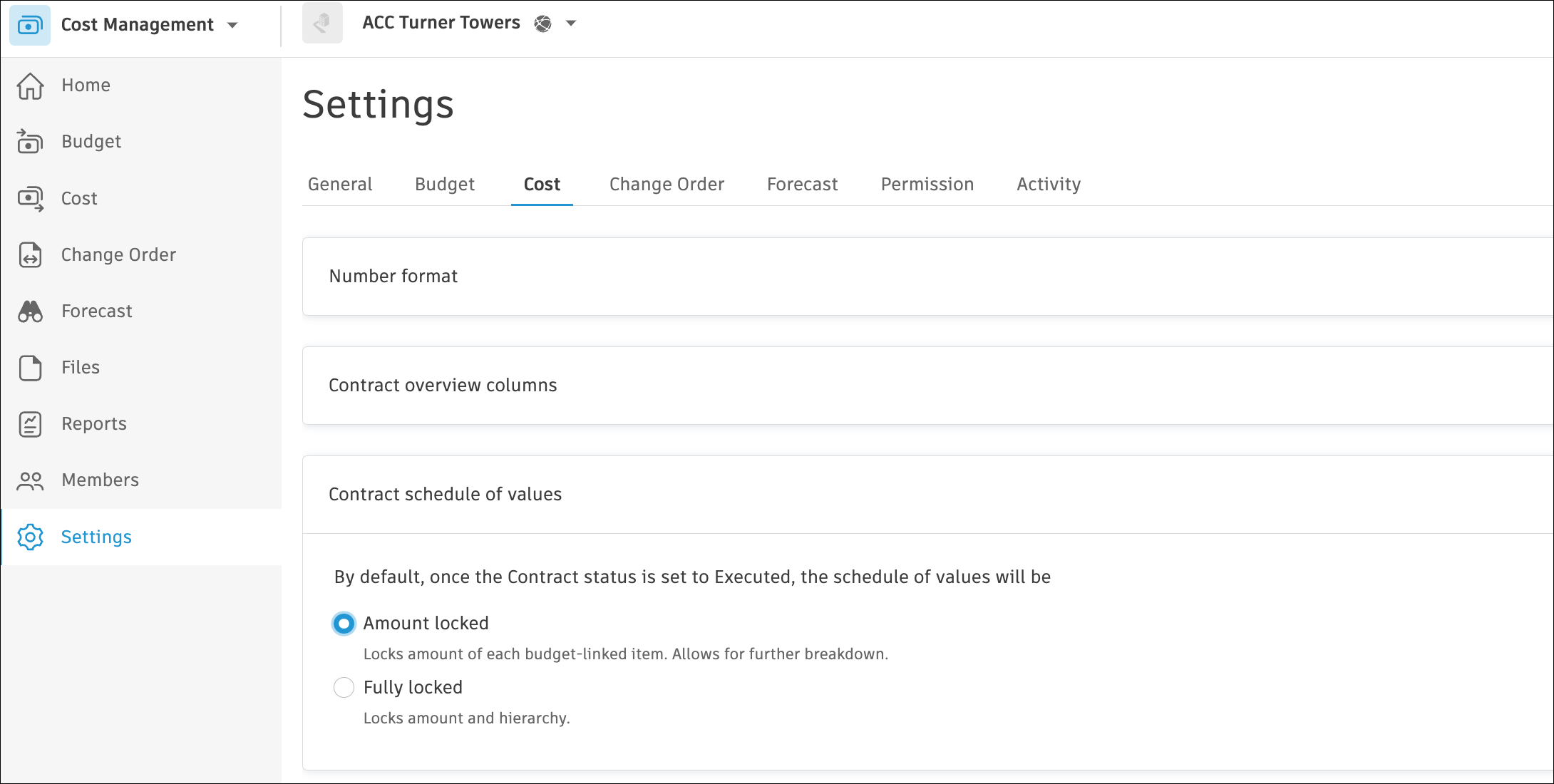

Depending on how your preference is set up and whether you fill out the contract SOV before or after the contract is executed and integrated to the ERP, please check your settings. Ensure you are using the appropriate setting in Settings/Contract Schedule of Values.

Note: Once status set as Fully Locked and Integrated and Locked, users can no longer change status.

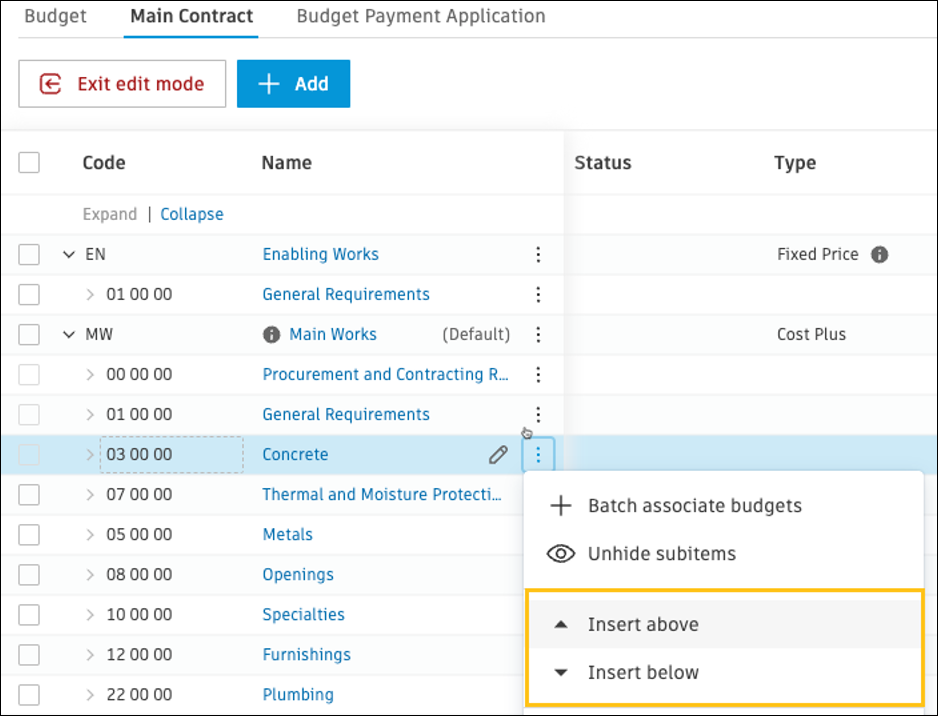

Main Contract SOV Enhancement – Two new context menu entries, Insert above and Insert below to make editing easier.

Custom Terminology Enhancement – Further to the recent enhancement to customize the term Accepted for cost changes, it has now been extended to Cost Payment Applications and Budget changes.

Change Orders

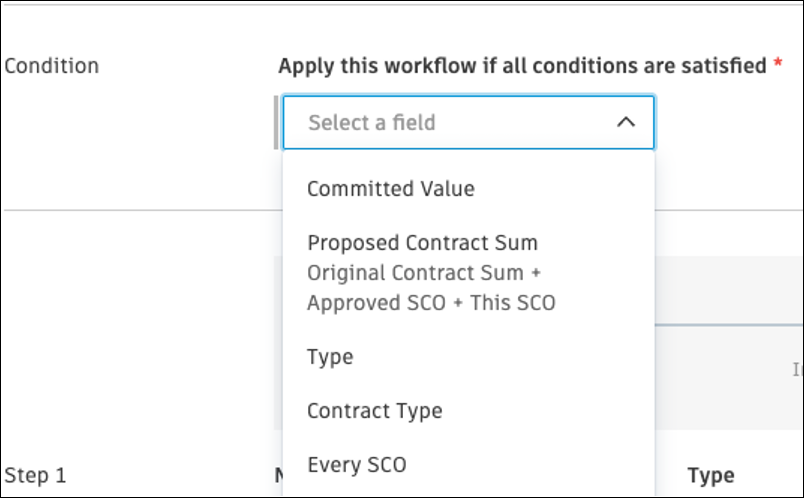

SCO Change Approval Workflow Rule Enhancements – Added new option to include value of total contract sum including the current SCO.

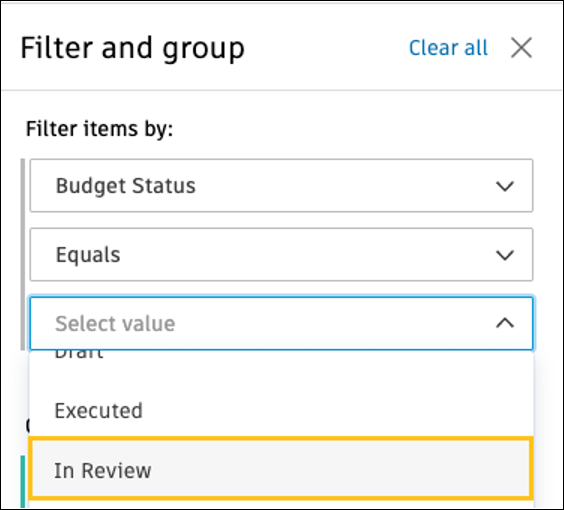

COR & PCO as COR Filter – Added In Review system filter.

COR variables – Added Revised At variable.

Forecast

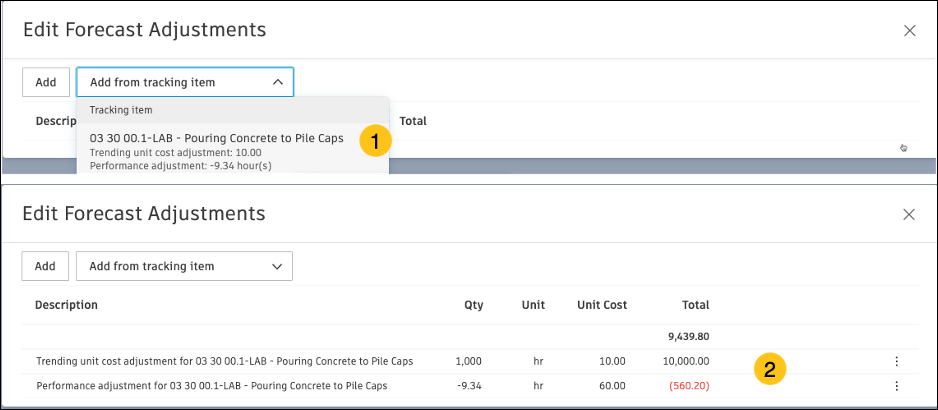

Performance Tracking Enhancement – To improve automated forecast adjustment calculation in Performance Tracking, the system now creates two adjustments when an item is affected by performance level and trending unit cost change. This occurs when members select add adjustment from a tracking item or instance, providing better auditability.
