Share

Cash Flow Forecasting

Access a project-level cash flow analysis and quickly visualize the difference between planned, actual, and forecast with built-in dynamic charts.

When all budget line items are forecasted, you can go to the Cash Flow tab to see a project-level cash flow analysis and the planned and actual forecast. Based on that, you can investigate details. The Cash Flow tab is a centralized place to create and manage all cash flow distributions.

Quick Navigation

In this article:

Set Preferred Forecast Period

Within the Settings tool, project administrators can set preferred forecast periods; weekly or monthly. Once a forecast distribution is created on any budget item this setting cannot be changed.

See the Forecast Setting to learn more.

Create a Distribution Item

You can create distribution items to see how your budget is performing at a project level with four built-in curves.

Note: You can choose between weekly and monthly forecasting distribution in the Forecast settings section, and configure how distribution items will be created.

To create a distribution item:

  1. Go to the Cash Flow tab within the Forecast tool.

  2. If there are no distribution items created yet, you'll see Add distribution item there:

    Add distribution item button

    However, if there are existing items, the Add distribution item button shows at the top:

    Add distribution item button at top

  3. Now you can choose what will be the base for a distribution item: Budget, Budget code segment, or Contract.

    Distribution window options

  4. Select distribution items and click Add.

    Tip: You may need a permission to view items on those lists. Contact a project administrator to obtain permissions. For the Budget tab, you'll need View All or Full Control. For the Contract tab, you'll need Collaborate, View All, or Full Control. Learn more about Cost Management's permissions.

Distribution items are added to the Revised Budget list, the detailed view of the Cash Flow tab. In the Cost & Time tab, you can connect budgets to schedule tasks, but actual distribution is done in the cash flow view. To create a distribution, you need to have created scheduled tasks.

Create a Distribution

After creating a schedule task and a distribution item, you can create cash flow distribution to see a project-level cash flow analysis and the planned and actual forecast. To do so:

  1. Go to the Cash Flow tab within the Forecast tool.

  2. Open the distribution item list view of Revised Budget or Forecast Final Cost. In our scenario, we clicked Revised Budget. The detailed view of Revised Budget opens. If project administrator allows budget forecasting, here you'll see Forecast Final Budget.

    Open distribution item list view

  3. You'll see the list of distribution items. Click the More menu More menu icon next to the one you want to create a distribution.

    Distribute option

  4. Choose distribution start and end dates. Choose the style of the cash flow curve.

    Note: Date range resources are available for distribution in the cash flow view. You can view quantities per period as an alternative to dollars, and add resources bidirectionally between distribution items and cash flow views. See Quantity Distribution to learn more. To configure date range resource frequency settings, see Date Range Based Resources.

The distribution is created. You'll see the table with created distribution, divided into months and years, and you can load more periods when available.

Load more periods option

You can override dates if preferred.

Create distribution from multiple distribution items

To create a distribution based on multiple distribution items, select the distribution items and click Distribute at the top of the page.

Multiple items distribution

Automated Forecast Adjustments

You can redistribute your forecast at any time, whether you have actual costs or not. This flexibility lets you adjust your cash flow forecast as your project evolves.

When you have actual costs: If the value of a specific period on the Forecast Final Cost (or Forecast Final Budget) curve doesn't match the corresponding period on the Actual Cost curve, an indicator will appear in the distribution item list view.

Forecast adjustments indicator

Starting redistribution: Select Redistribute from the context menu to open the redistribution dialog.

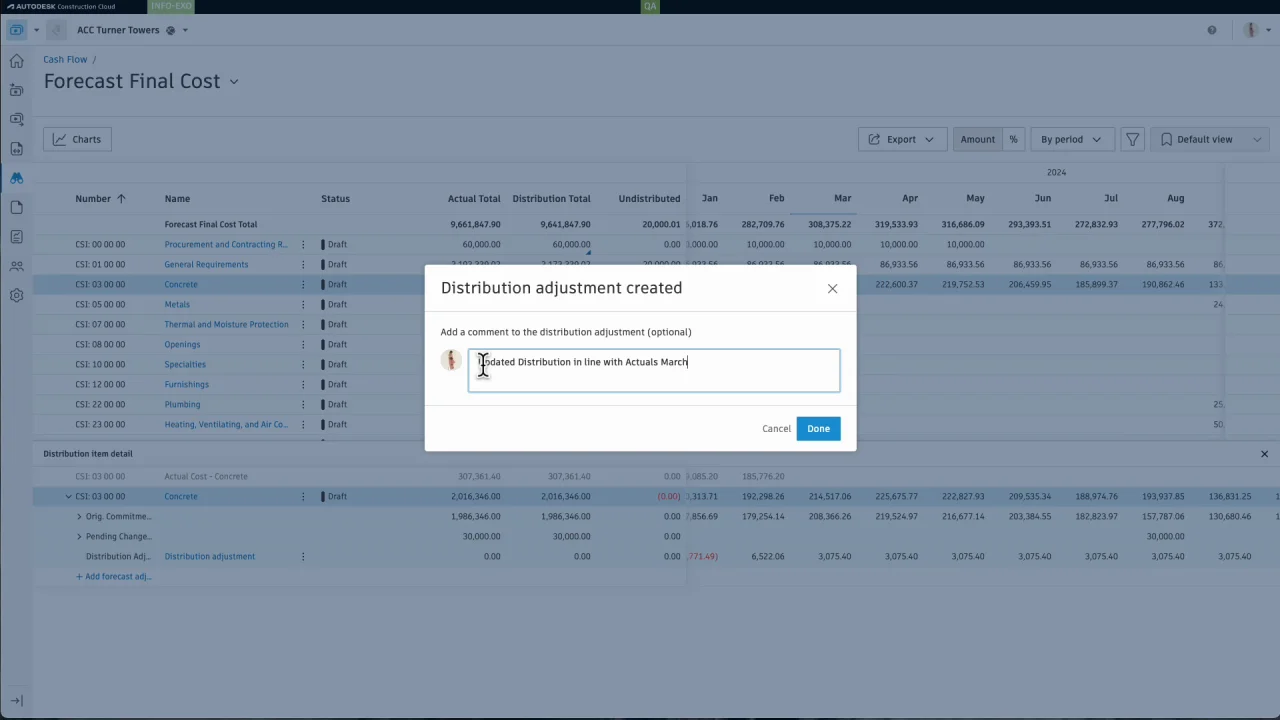

Redistribute based on actual cost

Redistribution Options

The redistribution dialog shows different options depending on whether you have actual costs:

Use current actual cost for past periods toggle:

  • Toggle ON: Match past periods to actual costs (when available), then redistribute remaining periods
  • Toggle OFF: Ignore actual costs and redistribute all periods using forecast calculations

When the toggle is ON and you have actual costs, you'll see three options for handling remaining periods:

  • Keep the same Forecast Final Cost: Evenly distribute the variance across remaining periods
  • Calculate new Forecast Final Cost: Use average cost, manual trending, or % complete to recalculate
  • Edit each period manually: Manually adjust each remaining period

How Different Scenarios Work

Scenario What Happens
No actual costs exist The "Use current actual cost for past periods" toggle is unavailable. You redistribute all periods using one of the calculation methods (average cost, manual trending, or % complete) or edit each period manually.
Some actuals exist, but not all periods are final
  • Toggle ON: Past periods match actual costs. Remaining periods are redistributed based on your chosen method.
  • Toggle OFF: All periods are redistributed, ignoring existing actual costs.
All periods are final All periods match actual costs. The redistribution adjusts the distribution to align with actual spending patterns.

Keep the Same Forecast Final Cost

When you select this option and have actual costs:

  • Past periods are adjusted to match the actual cost (the current period is not included in these adjustments)
  • The variance resulting from adjusting past periods is evenly spread across the remaining periods

When you don't have actual costs or toggle OFF "Use current actual cost for past periods":

  • The system redistributes all periods while keeping the same total forecast final cost

After clicking Redistribute, the distribution item line becomes editable with Cancel and Confirm buttons at the right end of the row.

Calculate New Forecast Final Cost

This option recalculates the forecast final cost based on one of three methods:

Calculate from Average Cost

  • Average cost is determined by the sum of actual costs from past periods, divided by the number of these periods
  • If no actuals exist, the calculation uses the distributed amounts from past periods

Calculate from Manual Trending Cost

  • When actual costs exist, this uses the actual cost from the last past period
  • When no actuals exist, this uses the distributed amount from the last past period

Calculate from % Complete

  • With actuals: The new final cost is determined by dividing the actual cost by the percentage complete
  • Without actuals: The calculation is based on distributed amounts
  • A multiplier (calculated by dividing the new remaining cost by the current remaining cost) is applied to each remaining period

Edit Each Period Manually

Select this option to manually adjust the distribution for each period:

  • The remaining periods retain their current values but can be modified as needed
  • Open the distribution detailed view to edit values in relevant periods
  • This option is useful when you need precise control over specific period amounts

Tips for Redistribution

General guidelines:

  • The distribution adjustment is uneditable but can be deleted
  • A dialog box allows for an optional comment on the distribution adjustment. No email notifications will be sent for this comment
  • Distribution adjustment will not be created under any budget and is only visible in cash flow
  • Adding or deleting a period will not affect the distribution adjustment

Working with periods:

  • You can extend the last period by selecting "Add new period" in the end period drop-down. Extended periods need to be manually selected as the end period
  • If redistributing with the extended end period, the extended periods will be created. Otherwise, they won't be created
  • You can move the last period earlier by selecting an earlier period in the end period drop-down. Periods after the new last period will be adjusted to 0.00 in the editing state
  • Distribution adjustments are created after confirming the redistribution

Date range resources:

  • The "Use current actual cost for past periods" toggle works with date range resources
  • When the current period is before the first period or there's no actual cost, the toggle is off and disabled

Here is a demo of Automated Forecast Adjustments in action:

Wistia video thumbnail

Create Forecast Adjustments

Apart from automated forecast adjustments you can also create adjustments manually.

In our scenario, we're adjusting Forecast Final Cost to New Traveling PM Budget. To do so:

  1. Click the blue triangle in the Distribution Total.

  2. Choose Add forecast adjustment in the flyout panel.

    Add forecast adjustments workflow

  3. In the new window, choose a budget to add forecast adjustment to.

  4. Click Add.

  5. Name the new adjustment and approve it.

    Approve forecast adjustment

Now, open the distribution item detail view of New Traveling PM Budget and edit values in relevant periods.

You can add forecast adjustments in the same way in Revised Budget (or Forecast Final Budget, when budget forecasting is on) and Forecast Final Cost.

Tip: Once you've created forecast adjustments, you can generate PCOs from them to request extra budget changes or create budget transfers from them to move money between budget items.

Quantity Distribution

Use Quantity Distribution to track your cash flow with quantities and units (hours, days, weeks) alongside dollar amounts. This helps you manage labor budgets and time-based work by showing both the amount of work and when it will happen.

Example Scenario: When you create budgets using quantities and unit costs (for example, 100 hours × $50/hour = $5,000), the system only tracks the total dollar amount ($5,000) and loses the original quantity information (100 hours).

The Solution: Quantity distribution preserves both the dollar amounts and the original quantities, allowing you to:

  • Plan work schedules based on available hours/days
  • Forecast resource needs more accurately
  • Adjust timelines by changing quantities rather than just dollar amounts

Viewing quantity distribution

To work with quantity distribution, open distribution item list view:

Distribution item list view

Then you can:

  1. Toggle views: Switch between "Amount" and "Input Qty" views using the toggle button.

    • Amount view: Shows dollar values and percentages.
    • Input Qty view: Shows quantities and percentages.
  2. Work with the Unit column: When in quantity view, you'll see a "Unit" column showing:

    • Budget items: The budget's original unit (hours, days, and more).
    • Segment/Contract items: Shows hours.

Input quantity distribution view

How quantity distribution works

This feature is most valuable for labor and other time-based work. Try to use consistent time units within similar types of work. Update both quantities and amounts as your project progresses. Pay attention to unit costs when adjusting to ensure they remain realistic.

Key features:

  1. Forecast adjustments. When adding forecast adjustments:

    1. Enter a unit cost (for example, $75/hour).
    2. The system calculates quantities automatically based on your dollar adjustments.
    3. This unit cost applies to all time periods in the adjustment.
  2. Redistribute based on actual cost: When you redistribute amounts based on actual costs, the system also redistributes quantities proportionally, keeping your quantity forecasts aligned with actual progress.

  3. Modify quantity and unit cost per period after forecast adjustment was added. To do so, in the consolidated view:

    1. Click Edit input qty & unit cost.

      Edit input quantity

    2. Edit distribution.

      Edit distribution

Note: If a budget doesn't have original quantity information and isn't time-based, the quantity distribution will show empty values. This is normal for lump-sum contracts or material budgets without unit breakdowns.

Default units and how to change them

The system automatically selects appropriate units:

  • Time-based budgets: Uses the budget's original unit (hr, d, wk, mo)
  • Nontime-based budgets: Defaults to hours (hr)
  • Segment/Contract distributions: Uses hours (hr)

For time-based distributions, you can switch between different time units: hr (hours), d (days), wk (weeks), mo (months).

The system automatically converts quantities when you change units (for example, 40 hours becomes 1 week).

Update a Distribution

An Undistributed column advises of any differences between the amount in the budget view and the currently distributed. Selecting the More menu More menu icon next to the item with an orange triangle allows you to add in undistributed items for change orders or transfers, so they can be distributed separately from the original work.

Add to distribution item

After adding to the distribution item, you'll see the detailed view:

Undistributed items view

You can distribute those items using the predefined curves or manually.

Manual distribution

Approved Owner Changes and Internal Budget Transfer amounts are shown in a different color in the chart.

Different colors chart

Clear a Distribution

To clear a distribution, click the More menu More menu icon next to a distribution item and select Clear distribution.

Clear distribution option

Delete a Distribution Item

To delete a distribution item, click the More menu More menu icon and then select Delete. To delete more than one distribution item, select boxes next to items you want to delete, and then click Delete.

Delete distribution item

In both cases, you'll be prompted to confirm the action.

Distribution Item in the Collaborative Workflow

The collaborative functionality in the Forecast tool allows users to send distribution items to suppliers and ask for their input.

Learn more about the Cash Flow Collaborative Workflow.

Learn how to:

Teams can access a project-level cash flow analysis to easily visualize the cash flow distribution throughout the project lifecycle. This real-time summary enables teams to see planned actual and forecast quickly with all the details, when necessary. To access the Cash Flow table, open the Forecast tool.

To display the built-in dynamic time-versus-money chart, select the Chart icon icon. Then, you can:

  • Toggle between amount and percent.
  • Use the drop-down list to select By Period or Cumulative to change the view of the chart.
  • Use the settings icon Settings icon to display Cumulative, by Period, or both.
  • Select one of the legend items (Revised Budget, Work Completed, Actual Cost, or Forecast Final Cost). Clicking each name reduces the chart to only show the selected data. To get back to the project summary with all four legends active, select one from the table view. You can now select the Charts icon near Project Summary to enable the default view.
  • Hover over a period to get a list view of the details.

Cash flow chart details

You can manipulate the Cash Flow table by using the Settings icon icon:

  • Check or clear columns' checkboxes to change their visibility.
  • Use the Handle icon icon to drag columns to a different location.
  • Use the Snap icon icons to snap a column to the left or right.

You can also see more details by selecting the Popout icon icon that appears in the table when hovering over a line:

Distribution item list view

The view of the budget for the specific column opens. Add distribution items and create cash flow distributions from this view. Click budget items with the Popout icon icon to see a more detailed forecast. Periods are divided into months and years, with extra periods available to load when needed.

Forecast in budget details

Cash flow periods are dynamic. Therefore, period column position and visibility cannot be saved in cash flow saved views. Only the following columns will be kept in saved views:

  • Number
  • Name
  • Actual Total
  • Distribution Total
  • Undistributed

Consolidated view

You can view and edit the details of a distribution item on the list, and also see the cash flow context of other distribution items, by displaying these details in a subtable.

To display distribution item details in a subtable in the list view:

  1. Select any Distribution Total that has a blue triangle indicator to expand the subtable.

    Cash flow consolidated view

  2. You can now edit the details of an item and see other items.

Forecast adjustments across tools

Other forecast tools and workflows

Was this information helpful?
